|
|
|
|
AGENDA
Ordinary Council Meeting Tuesday, 30 June 2020 |
|
|
I hereby give notice that an Ordinary Meeting of Murray River Council will be held on: |
|
|
Date: |
Tuesday, 30 June 2020 |
|
Time: |
6:00PM |
|
Location: |
Council Chambers Moama Administration Office 52 Perricoota Road, Moama |
|
Des Bilske General Manager |
|
|
MURRAY RIVER COUNCIL Ordinary Council Meeting Agenda |
30 June 2020 |
3 Apologies & Applications for a Leave of Absence
4.1 Confirmation of Minutes - Ordinary Meeting of Murray River Council held on 26 May 2020
8.1 General Manager’s Report & Supplementary Matters
8.1.1 Local Government NSW Annual Conference 2020.
8.1.2 Resolutions of the Council - Resolution Tracker & InfoCouncil Action Reports
8.1.3 Local Road and Community Infrastructure Program.
8.2 Director Corporate Services Report & Supplementary Matters
8.2.1 C2002 PROVISION OF TELECOMMUNICATIONS SERVICES (DATA SERVICES) - UPDATE TO COUNCIL

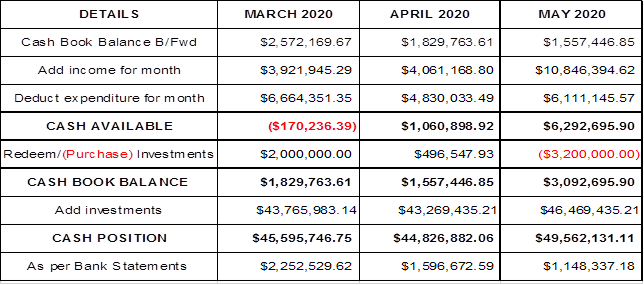

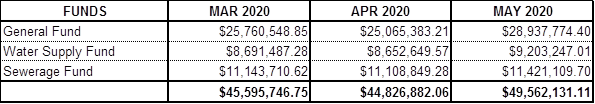

8.2.2 Financial Statements & Investments as at 31 May 2020
8.2.3 Budget Update for Maiden Smith Drive Stormwater Works
8.2.4 2019/20 Capital Works Carryover Report
8.3 Director Engineering Report & Supplementary Matters
8.3.1 Purchase request - Lot 5_DP861750 - Barham
8.3.2 Major Projects Progress Update
8.3.3 Murray River Council Local Traffic Committee Recommendation
8.4 Director Planning, Waste & Regulatory Services Report & Supplementary Matters
8.4.1 Final Murray River Council Local Strategic Planning Statement
8.4.2 Finalisation of Planning Proposal to rezone Part Lot 52 DP 1220883 Boundary Road, Moama
8.4.3 Planning, Waste & Regulatory Services Directorate - Monthly Activity Report
9 Notice of Motions/Questions with Notice
10.1 Request for Tender C2007 Enterprise Resources Planning Solution
10.2 Request for Tender C2010 Provision of Services for the Land, Asset and Fleet Valuations
10.3 Aerial Imagery Capture Funds to Reserve
10.4 Meninya Street Offices - Lease Update
10.5 Economic Development and Tourism Business Unit - Monthly Report
10.6 Mayoral Minute - Stand in for General Manager
|
MURRAY RIVER COUNCIL Ordinary Council Meeting Agenda |
30 June 2020 |
File Number: -
Author: Rosemarie Lewandowski, Administration Officer Project
Authoriser: Des Bilske, General Manager
|
That the minutes of the Ordinary Meeting of Murray River Council held on 26 May 2020 be confirmed as a true and correct record. |
Discussion
Murray River Council held its Ordinary Meeting of the Council on Tuesday 26 May 2020, commencing at 6:00pm in the Council Chambers (Lower Level), Moama Administration Office, 52 Perricoota Road, Moama.
A copy of the draft minutes is attached for ratification by the Council at this meeting.
1. MINUTES
- Ordinary Meeting of Council 26 May 2020 ⇩ ![]()
|
MURRAY RIVER COUNCIL Ordinary Council Meeting Agenda |
30 June 2020 |
|
MURRAY RIVER COUNCIL Ordinary Council Meeting Agenda |
30 June 2020 |
8.1 General Manager’s Report & Supplementary Matters
File Number: -
Author: Kerri Keogh, Manager Office of the General Manager
Authoriser: Des Bilske, General Manager
|
That Council be represented at the Local Government NSW Annual Conference 2020, to be held 22-24 November at the Crowne Plaza Hunter Valley, by the Mayor, Deputy Mayor, General Manager and any other Councillor, as determined by the Council. |
Background
The Local Government NSW (LGNSW) Annual Conference is the annual policy-making event for NSW councils and associate members. It is the pre-eminent event of the local government year where councillors come together to share ideas and debate issues that shape the way councils are governed.
All NSW councils, regional, country and metropolitan, meet with an anticipated 800 attendees from across the state, inclusive of mayors, councillors, general managers and senior staff.
For the past three years, it has been the general practice of the Council to be represented at the Conference by the Mayor, Deputy Mayor, General Manager and any other Councillor, as determined by the Council.
Discussion
The LGNSW Annual Conference 2020 was originally scheduled to run from Sunday 11 October to Tuesday 13 October, but close proximity to the 2020 local government elections raised serious concerns for many councils around capacity to nominate delegates.
As Councillors are aware, and as reported to the Ordinary Meeting of Council of 28 April 2020, to provide certainty to councils, communities and potential candidates, the NSW Government has made the decision to postpone the September local government elections in the face of the COVID-19 crisis.
Therefore, the LGNSW Annual Conference 2020 will now be held from Sunday 22 November to Tuesday 24 November at the Crowne Plaza Hunter Valley. The program for the Conference is yet to be released.
The Council will need to establish representation to the Conference as a matter of urgency, as there is always a shortage of accommodation at this location.
It should also be noted that due to the travel logistics to get to the Hunter Valley, delegates will be travelling together to this Conference.
Cessnock City Council will co-host the Conference and assist with various aspects of the Conference, such as showcasing their unique and distinctive experiences at social functions and partners’ tours. With over 1.5 million visitors per year, Cessnock is bound to please delegates, their spouses and sponsors alike.
Strategic Implications
5 - Strategic Theme 5: Leadership and Governance
5.4 - Develop and pursue advocacy on behalf of the community
5.4.2 - Identify opportunities to partner with other organisations or agencies to increase advocacy effectiveness and positive outcomes for the community
Budgetary Implications
There are allocations in Council’s annual budget for attendance at conferences by Councillors and the General Manager.
Policy Implications
Nil.
Legislative Implications
Risk Analysis
· What can happen?
Nil.
· How can it happen?
Nil.
· What are the consequences of the event happening?
Nil.
· What is the likelihood of the event happening?
Nil.
· Adequacy of existing controls?
Nil.
· Treatment options to mitigate the risk?
Nil.
Conclusion
The LGNSW Annual Conference 2020 will be held from Sunday 22 November to Tuesday 24 November at the Crowne Plaza Hunter Valley. The Council will need to establish representation to the Conference.
|
MURRAY RIVER COUNCIL Ordinary Council Meeting Agenda |
30 June 2020 |
File Number: -
Author: Kerri Keogh, Manager Office of the General Manager
Authoriser: Des Bilske, General Manager
|
That the Council receives and notes the status of previous resolutions of Council (in open and closed Council) contained in both the manual Resolution Tracker and InfoCouncil Action Reports. |
Background
As Councillors are aware, in September 2018 a manual Resolution Tracker (pertaining to the resolutions of the previous Council meetings) was introduced as part of the General Manager’s report to each Council meeting to allow Councillors to review the current status (actions by Council’s officers) of their decisions (resolutions).
In November 2018, Council introduced a report and minute software called InfoCouncil. Resolutions of the Council that require action after each Council Meeting are automatically generated in InfoCouncil to the relevant Council officer for their action and comment.
Subsequently, the manual Resolution Tracker is now superseded by the InfoCouncil Action Report. Once all resolutions in the manual Resolution Tracker have been completed by Council’s officers, the document will be archived.
Discussion
The manual Resolution Tracker (Attachment 1) comprises ‘active’ resolutions from meetings of the Council held in August to October 2018 (prior to the implementation of InfoCouncil) that require action by Council’s officers. Resolutions that are reported by Council’s officers as complete will drop off the ‘active’ list.
The InfoCouncil “Open” Action Report (Attachment 2) comprises ‘active’ resolutions from meetings of the Council held since the introduction of InfoCouncil in November 2018 that require action by Council’s officers. Comments provided on the action are shown below each active resolution of the Council. Resolutions that are reported by Council’s officers as complete will drop off the ‘active’ list.
The InfoCouncil “Confidential” Action Report (Attachment 3) comprises ‘active’ confidential resolutions from meetings of the Council held since the introduction of InfoCouncil that require action by Council’s officers. Comments provided on the action are shown below each active resolution of the Council. Resolutions that are reported by Council’s officers as complete will drop off the ‘active’ list.
Strategic Implications
5 - Strategic Theme 5: Leadership and Governance
5.1 - An effective, efficient and progressive Council that provides leadership to the community
5.1.1 - Council decision making takes into account the needs and priorities of our local communities and the longer term social, cultural, economic and environmental viability and sustainability of our region
Budgetary Implications
Nil.
Policy Implications
Nil.
Legislative Implications
Nil.
Risk Analysis
· What can happen?
Council’s officers do not action the resolutions of the Council.
· How can it happen?
Resolutions from Council Meetings not being recorded in a systematic fashion.
· What are the consequences of the event happening?
Actions, as a result of the resolutions of the Council, not being completed in a timely manner or at all.
· What is the likelihood of the event happening?
Low.
· Adequacy of existing controls?
Use of the report and minute system, InfoCouncil, which automatically forwards actions (as a result of the resolutions of the Council) from Council Meetings to the relevant Council officer (report writer) after the completion of the minutes of a Council Meeting. A report can then be generated on the status of incomplete/outstanding actions.
· Treatment options to mitigate the risk?
Due diligence undertaken by Council’s officers (administration and report writers).
Conclusion
In September 2018, a manual Resolution Tracker (pertaining to the resolutions of the previous Council meetings) was introduced as part of the General Manager’s report to each Council meeting to allow Councillors to review the current status (actions by Council’s officers) of their decisions (resolutions). It was superseded by the introduction of Council’s report and minute software, InfoCouncil, in November 2018, whereby action reports (of Council Meeting resolutions that require action by a Council officer) are automatically generated after every Council meeting. The Resolution Tracker and Action Report are presented to Councillors for information.
1. MRC
Resolution Tracker June 2020 ⇩ ![]()
2. Resolution
Tracker "Open" June 2020 ⇩ ![]()
3. Resolution
Tracker "Confidential" June 2020 ⇩ ![]()
|
MURRAY RIVER COUNCIL Ordinary Council Meeting Agenda |
30 June 2020 |
File Number: -
Author: John Harvie, Manager Economic Development & Tourism
Authoriser: Des Bilske, General Manager
|
That Council 1. Acknowledge allocation of $1,861,814 through the Local Roads and Community Infrastructure Program. 2. Agree to fund the projects listed in Table 1 to a total value of $1,861,814.
|
Background
The Federal Government recently announced a roads and infrastructure stimulus package totalling $500 million. The funding will be administered by Local Government with each council receiving a pre-determined funding allocation.
The roads and infrastructure boost is part of a $1.8 billion stimulus package which includes the bringing forward of $1.3 billion worth of Financial Assistance Grants.
The intent of the funding is to accelerate priority projects, provide local employment, support local businesses and stimulate the economy.
Murray River Council has been allocated $1,861,814 as its share of the Local Roads and Community Infrastructure Program.
Discussion
Following the announcement of the funding council officers have developed a priority roads and infrastructure projects list that comprises projects that were not able to be funded within council’s 2020/21 budget. The list is shown in Table 1 below.
Table 1.
|
Project description |
Projected cost |
Priority |
|
Rangemore Road/Jimaringle Creek Bridge or Nacurrie Road North Flood Opening Bridge |
$800,000.00 |
1 High |
|
Repair Noorong Street pavement |
$70,000.00 |
1 High |
|
Construct footpath- Mathoura Street - Mathoura |
$43,514.00 |
1 High |
|
Reseal and repair Kilkerrin Drive - Moama |
$95,000.00 |
1 High |
|
Construct Lignum Road - Moama |
$680,000.00 |
2 Medium |
|
Construct paved footpath Noorong Street - Barham |
$30,000.00 |
2 Medium |
|
Construct Bike Path - Picnic Point Road - Mathoura |
$55,300.00 |
2 Medium |
|
Repair Punt Road pavement |
$55,000.00 |
2 Medium |
|
Construct paved footpath Riverside Park – Barham |
$33,000.00 |
2 Medium |
|
TOTAL |
$1,8161,514 |
|
|
Mathoura Visitor Attraction Project* |
$300,000 |
1 High |
*Indicates that the Mathoura Visitor Attraction Project will only be funded if the Rangemore Road/Jimaringle Creek Bridge receives funding from another source.
Strategic Implications
1 - Strategic Theme 1: Built/Physical Environment
1.2 - Improve and maintain our road and transport network
1.2.1 - Develop long-term plans for maintenance and construction of town streets and the rural road network - with priorities established in conjunction with the community
Budgetary Implications

There are no negative implications for council’s 2020/21 budget. Council has received $1,861,814 in funding and only $1,861,814 will be allocated to fund the projects in Table 1.
Policy Implications
Nil.
Legislative Implications
Risk Analysis
· What can happen?
Nil
· How can it happen?
NA
· What are the consequences of the event happening?
NA
· What is the likelihood of the event happening?
NA
· Adequacy of existing controls?
NA
· Treatment options to mitigate the risk?
NA
Conclusion
The funding received through the Local Road and Community Infrastructure Program is an unexpected windfall for council and will enable completion of priority road and infrastructure projects that would not otherwise have been funded in 2020/21.

1. Local
Road and Community Infrastructure Fact Sheet ⇩ ![]()
|
MURRAY RIVER COUNCIL Ordinary Council Meeting Agenda |
30 June 2020 |
File Number: -
Author: John Harvie, Manager Economic Development & Tourism
Authoriser: Des Bilske, General Manager
|
That Council receive and note the Funding Opportunities Report as at June 2020 |
Background
The purpose of this report is to provide an update on current funding opportunities.
Discussion
Council has received funding under the following programs:-
Showground Stimulus Funding 2019/2020
|
Wakool Showground |
Purchase and install RV dump point |
$7,000 |
|
Wakool Showground |
Upgrade synthetic netball court markings with tennis court lines |
$3,000 |
|
Wakool Showground |
Vehicle parking area power head upgrades |
$10,000 |
|
Wakool Showground |
Purchase and install directional signage RV friendly |
$5,000 |
|
Wakool Showground |
Upgrade storage facilities Wakool Bowling Club |
$15,000 |
|
Moama Rec Reserve |
Upgrade toilet block Jack Eddy Oval |
$20,000 |
|
Moama Rec Reserve |
Upgrade toilet block Brick Alley Oval |
$15,000 |
|
Moama Rec Reserve |
Ground seating main oval |
$30,000 |
|
Barham Showground |
Upgrade kitchen facilities Lawson Pavilion |
$70,000 |
|
Barham Showground |
Upgrade access and entrance Lawson Pavilion |
$60,000 |
Drought Communities Program – Tranche 2
|
Barham |
Micro Abattoir – commencement of site works and connection to power |
$375,000 |
|
Wakool |
Bowling Club renovation and refurb |
$350,000 |
|
Murray River Council |
Tourism & Marketing Promotion River Country |
$100,000 |
|
Tooleybuc |
New section sealed track |
$80,000 |
|
Moulamein |
Heritage Village – Stage 2 |
$95,000 |
Council has recently applied for funding under the following programs:-
Showground Stimulus Funding 2020/2021
|
Wakool Showground |
Oval irrigation upgrade |
$75,000 |
|
Moama Rec Reserve |
Carpark upgrade Main Oval |
$150,000 |
|
Moama Rec Reserve |
Carpark upgrade Brick Alley Oval |
$150,000 |
|
Barham Showground |
New entrance to showground |
$20,000 |
Streets as Shared Spaces
|
Moama |
Perricoota Road installation of temporary seating, bike racks, water refill stations and landscaping |
$50,000 |
|
Moama |
Pop up green space off Chanter St Moama |
$30,000 |
|
Moama |
Bridge underpass sound/light projection |
$195,000 |
|
Moama |
Perricoota Road shared path solar lighting |
$95,000 |
|
Moama |
Cobb Hwy shared path solar lighting |
$91,500 |
|
Murray River Council |
Christmas Pop Up Tooleybuc, Koraleigh, Moulamein, Wakool, Barham and Mathoura |
$120,000 |
Community Building Partnerships Program
|
Moama |
Moama Foreshore Toilet Block |
$95,000 |
|
Moulamein |
Howard Park Refurbishment |
$30,000 |
|
Barham |
Thule-Yarrein Shared Bike Path |
$30,000 |
Crown Reserves Improvement Fund
|
Wakool Rec Reserve |
Upgrade amenities pavilion |
$40,000 |
|
Wakool Rec Reserve |
Purchase and install solar lighting |
$25,000 |
|
Barham Rec Reserve |
Upgrade and stabilise internal road (east and west) |
$80,000 |
|
Barham Rec Reserve |
Ground seating for new pavilion and main oval |
$30,000 |
|
Barham Rec Reserve |
Upgrade Toilet Block |
$20,000 |
|
Moama Rec Reserve |
Oval perimeter fencing Brick Alley Oval |
$30,000 |
|
Moama Rec Reserve |
Carpark upgrade main Oval |
$150,000 |
|
Moama Rec Reserve |
Internal road upgrades as per master plan |
$75,000 |
|
Horseshoe Lagoon |
Walkway upgrade |
$95,000 |
|
Horseshoe Lagoon |
Connection of power and water to wharf |
$50,000 |
|
Barham |
Bike path solar lighting and gym equipment |
$35,000 |
|
Moama Foreshore |
Fixing retaining wall, lighting, under bridge connection as per Master Plan |
$750,000 |
|
Picnic Point |
Retaining wall failure |
$140,000 |
|
Blair Street |
New Demountable Toilet Block |
$100,000 |
Not for profit/community group grants and other funding opportunities June 2020:
See attachment.
Strategic Implications
4 - Strategic Theme 4: Economic Growth
4.1 - Encourage and support economic development across a range of sectors
4.1.2 - Support the local business sector to grow, adapt and respond to new opportunities
Budgetary Implications
Nil, Projects will be fully funded if successful
Policy Implications
Nil.
Legislative Implications
Risk Analysis
· What can happen?
Nil
· How can it happen?
NA
· What are the consequences of the event happening?
NA
· What is the likelihood of the event happening?
NA
· Adequacy of existing controls?
NA
· Treatment options to mitigate the risk?
NA
Conclusion
Council has had significant success with a number of funding applications that will benefit our communities. A number of other applications are still pending outcomes. Attached to the report are various grant funding opportunities which are available to community groups. The list is also available on councils website and has been distributed via the Economic Development database
|
MURRAY RIVER COUNCIL Ordinary Council Meeting Agenda |
30 June 2020 |
8.2 Director Corporate Services Report & Supplementary Matters
File Number: -
Author: Robert Folbigg, IT Consultant
Authoriser: Ross Mallett, Director Corporate Services
|
That Council acknowledge the termination of contract C2002 Telecommunication Services (DATA SERVICES) valued at $424,656; and accepts these services will now be provided to council as included items of C1935 IT Transformation and Managed Services from Centorrino Technologies Pty Ltd as included in their tender response and contract. |
Background
At the ordinary Council meeting of 28 January 2020, Council approved the contract for engagement of Telstra in providing a managed wide area network to service all MRC offices valued at $424,656 over 3 years with option to extend for a further 2 years.
After further evaluation it was evident that the network offered by Centorrino Technologies Pty Ltd as part of the tender response to C1935 IT Transformation and Managed Services would provide a more robust network for MRC to reliably operate upon with fewer bottlenecks resulting from dealing with multiple vendors.
No penalties will be incurred by Council. Council notified Telstra of its intention to cancel C2002 prior to the full execution of the contract.
Discussion
The Wide Area Network (WAN) that will be delivered by Centorrino Technologies Pty Ltd consists of Fibre Optic, NBN and 4G service provisioned by multiple vendors with several layers of redundancy built in. These services will be delivered to all council sites.
Centorrino Technologies Pty Ltd has been able to satisfy council that they are able to meet all of council’s requirements and provide a greater level of support and efficiency in IT operations. Alex Green, Manager – Technology & Digital Services has recommended council utilise Centorrino Technologies Pty Ltd to deliver these services and they were included in C1935 IT Transformation and Managed Services.
These services accounted for $290,506.44 of the total investment relating to C1935 IT Transformation and Managed Services. Centorrino Technologies are also supplying telecommunication services to locations that were not included in Telstra’s offer e.g. Water and Sewage Treatment Plants which will enable greater integration, visibility and productivity within these sites.
Strategic Implications
5 - Strategic Theme 5: Leadership and Governance
5.1 - An effective, efficient and progressive Council that provides leadership to the community
5.1.2 - Council acts in a financially responsible manner to ensure delivery of safe and sustainable services to the community
Budgetary Implications
At the ordinary Council meeting of 28 January 2020, an amount of $424,656 was approved for the engagement of Telstra to supply council with a managed wide area network to all major council offices. These services have been included in C1935 at a cost of $290,506.44 to council. There are no penalties for cancelling C2002 as notice of cancelation was served prior to full execution of the contract.
Policy Implications
Nil.
Legislative Implications
Risk Analysis
· What can happen?
N/A
· How can it happen?
N/A
· What are the consequences of the event happening?
N/A
· What is the likelihood of the event happening?
N/A
· Adequacy of existing controls?
N/A
· Treatment options to mitigate the risk?
N/A
Conclusion
Council acknowledges the cancelation of contract C2002 in light of these services now being offered as part of C1935 at less cost to council with greater coverage and inclusions.
|
MURRAY RIVER COUNCIL Ordinary Council Meeting Agenda |
30 June 2020 |
File Number: -
Author: Peter Arthur, Contract Accountant
Authoriser: Ross Mallett, Director Corporate Services
|
That: 1. The Officer’s report on Council’s Financial Statements, Bank Reconciliations and Investments as at 31 May 2020 be received and noted by the Council. 2. The report detailing Council’s position of $49,562,131.11 as at 31 May 2020 is received by the Council. 3. The report detailing Council’s investment balance of $46,469,435.21 as at 31 May 2020 is received by the Council. |
Background
Refer below.
Discussion

Bank Reconciliation
Shown below are the Financial Statements, Bank Reconciliations and Investments for the period ending 31 May 2020.
Statement of Bank Balances of Council’s Combined Accounts as at 31 May 2020

Internal Cashbook Balances

OVERDRAFT LIMITS: Bank Overdraft - $650,000.00.
I hereby certify that the cashbook of the various funds of Council has been reconciled, with the appropriate Pass Sheets as at 31 May 2020.
Ross Mallett
Responsible Accounting Officer

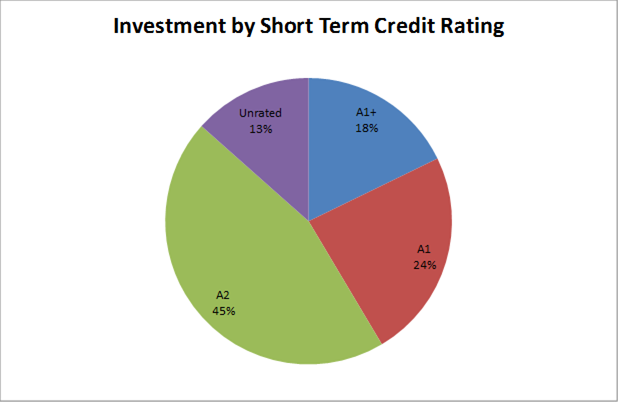

INVESTMENTS AS AT 31 MAY 2020
As required by Section 212 of the Local Government (General) Regulation 2005 and Section 625 of the Local Government Act 1993, the details of Council’s surplus funds invested, totalling $46,469,435.21 are listed below:

Strategic Implications
5 - Strategic Theme 5: Leadership and Governance
5.1 - An effective, efficient and progressive Council that provides leadership to the community
5.1.2 - Council acts in a financially responsible manner to ensure delivery of safe and sustainable services to the community
Budgetary Implications
Current low interest rates may reduce the expected interest revenue.
Policy Implications
Investments are made in accordance with the Council Investment Policy which was adopted on the 17th October 2017. This Policy is currently under review and a revised Policy will be submitted to Council for adoption in July 2020 to update investment criteria and provide better direction on investment limits.
Legislative Implications
Section 625 of the Local Government Act 1993
Regulation 212 of the Local Government (General) Regulations 2005
Trustees Act 1925 Section 14
Risk Analysis
· What can happen?
Imprudent use of Council’s financial resources.
· How can it happen?
Not following investment rules, policies or mandates.
· What are the consequences of the event happening?
Potential loss of financial resources.
· What is the likelihood of the event happening?
Low.
· Adequacy of existing controls?
Good.
· Treatment options to mitigate the risk?
Responsible management of financial resources invested in accordance with Council’s investment policies and mandate.
Conclusion
Murray River Council’s liquidity is in a satisfactory position at 31 May 2020.
|
MURRAY RIVER COUNCIL Ordinary Council Meeting Agenda |
30 June 2020 |
File Number: -
Author: Kris Kershaw, Assistant Manager Finance
Authoriser: Ross Mallett, Director Corporate Services
|
That 1. Council approve the budget variation for the Maiden Smith Drive stormwater works of $413,154, consisting of: (a) Internal reserve allocation of $252,082 from the Industrial Land Reserve Fund; (b) Internal loan borrowing of $161,072 from the Sewer Fund, for a period of 5 years at a fixed interest rate of 2.17% per annum.
|
Background
As per Resolution Number 691218 (December 2018) Council resolved to purchase a portion of Lot 15 DP 258661 located at 15 Maiden Smith Drive for the purpose of constructing a stormwater retention basin and stormwater pump station.
Works on the retention basin and pump station began in August 2019 and are progressing at the moment with final completion to be by July 2020.
Original budget for the project was set as $880,000. This was made up of the following allocations:
|
Funding Source |
Amount ($) |
|
Internal Reserve Allocation |
680,000 |
|
Stormwater Fund Section 94 |
200,000 |
|
Total Budget Allocation |
880,000 |
Discussion
The capital expenditure requirement for the project has increased from $880,000 to $1,275,014 due to additional unbudgeted expenditure of $252,082, which comprised of stormwater basin and pump station works in excess of the original budget and a variation to the scope of works during the design stage amounting to $161,072.
As a consequence of the additional unbudgeted expenditure the original budget allocation of $880,000 will not be sufficient to cover the project. In addition a review of the original budget has found that:
· The budgeted allocation of $200,000 from Stormwater Section 94 contributions has been reviewed and will not be available as there is only $58,860 in actual Stormwater Section 94 contributions available for this project (funds received by Council and available for use). The original $200,000 was based on the Stormwater Fund balance at the time the budget was set, however, some of the Stormwater Fund balance was already assigned to other stormwater capital projects at the time.
To assist with covering the shortfall in original budget ($200,000 less $58,860 = $141,140), Council staff have identified budget savings of $123,000 by reallocation of budgeted funds from the following projects. These projects haven’t yet commenced for the 2019/20 financial year:
|
Funding Source |
Amount ($) |
|
Moama Urban Roads - Merool Road |
80,000 |
|
Moama Street Reseals - Merool Road |
43,000 |
|
Total Budget Re-allocation |
123,000 |
The revised budget, taking into account the Section 94 and budget re-allocation movements, but not the additional unbudgeted capital expenditure, is:
|
Funding Source |
Amount ($) |
|
Internal Reserve Allocation |
680,000 |
|
Stormwater Fund Section 94 |
58,860 |
|
Budget Re-allocation |
123,000 |
|
Total Revised Budget Allocation |
861,860 |
As mentioned above the revised total capital expenditure budget of the works has been reviewed and is now estimated to be $1,275,014. This has resulted in a revenue budget shortfall of $413,154 ($1,275,014 less the revised budget of $861,860 above).
The budget shortfall of $413,154 is made up of two components:
1. Additional unbudgeted expenditure of $252,082, which comprised of stormwater basin and pump station works in excess of the original budget. This is the result of inadequate budget for the land purchase and scheduled works to be done.
2. A variation to the scope of works during the design stage of $161,072, which relates to the following items. The variations were the result of relocating services as a result of unexpected site conditions:
a. Gravel backfill and additional $73,872
b. Two large pits and dual pipe $27,200
c. Pump cabinet and valve pit $30,000
d. Power allowance $30,000
It is recommended that the shortfall of $413,154 be funded from the following options:
1. Internal reserve allocation of $252,082 from the Industrial Land Internal Reserve Fund. It is recommended to utilise this reserve up to the value of $252,082.
2. Internal loan borrowing of $161,072 from the Sewer Fund, for a period of 5 years at a fixed interest rate of 2.17% per annum.
Strategic Implications
1 - Strategic Theme 1: Built/Physical Environment
1.4 - Effectively plan for, improve and maintain water, sewer and waste
1.4.3 - Provide environmentally sensitive storm water collection and discharge systems appropriate to community needs
Budgetary Implications
Report is recommending a combination of internal loan and internal reserve allocation to fund the project difference of $413,154. If not approved, the costings affect the working capital bottom line.
Policy Implications
Nil.
Legislative Implications
Risk Analysis
· What can happen?
Overspend on original project budget.
· How can it happen?
Not monitoring all costs associated with the project and confirming budget allocations.
· What are the consequences of the event happening?
Majority of expenditure has already been incurred and project is nearing completion.
· What is the likelihood of the event happening?
High
· Adequacy of existing controls?
Adequate
· Treatment options to mitigate the risk?
Future capital works projects are costed by Project Managers and vetted by Finance.
Conclusion
Budget adjustment is the result of the original budget estimate been underestimated. Also, a variation to the project has added to the increase in overall revised budget.
|
MURRAY RIVER COUNCIL Ordinary Council Meeting Agenda |
30 June 2020 |
File Number: -
Author: Kris Kershaw, Assistant Manager Finance
Authoriser: Ross Mallett, Director Corporate Services
|
That Council approves the uncompleted works and services with a total remaining budget of $10,430,258 to be carried over from the 2019-20 Financial Year to the 2020-21 Financial Year. |
Background
This report identifies works that need to be carried over to the 2020-21 Financial Year to enable Council to achieve the objectives of the 2019-20 Operation Plan.
Discussion
Council, on the 25 June 2019, adopted a capital works budget as part of the 2019-20 Operational Plan. The original 2019-20 budget for capital works was $43.983 million and along with quarterly budget reviews in September 2019, December 2019 and March 2020, the revised capital works program across council is currently $46.740 million.
As at the time of preparing this report, approximately 72% of capital works projects had been completed, at work in progress or committed orders raised stage. Capital works projects not yet finished are either substantially progressed or delayed due to reasons beyond Council’s control. The carryover amount required to complete the Capital Works program across Council is $10.430 million representing approximately 22% of the revised approved program for 2019-20.
A list of the carryover capital projects has been provided as Annexure 1. Explanations for the carryovers are included in the attachment as well.
In accordance with Clause 211 of the Local Government (General) Regulation 2005, Council approval is required to carryover these funds and continue those projects in 2020/21.
Strategic Implications
5 - Strategic Theme 5: Leadership and Governance
5.1 - An effective, efficient and progressive Council that provides leadership to the community
5.1.2 - Council acts in a financially responsible manner to ensure delivery of safe and sustainable services to the community
Budgetary Implications
There is no budget implication as carryovers are currently funded in the 2019/20 financial year. If approved, the carryover total of $10,430,258 will be placed into internal and external reserve balances as at 30 June 2020 and then brought into the 2020/21 budget in July 2020.
Policy Implications
Nil.
Legislative Implications
Clause 211 of the Local Government (General) Regulation 2005
Risk Analysis
· What can happen?
Failure to complete 2019/2020 capital works program.
· How can it happen?
Council being delayed in circumstances beyond its control or a deficiency in resources to undertake the works within the allotted timeframe.
· What are the consequences of the event happening?
Council’s Delivery Plan and Operational Plan objectives/ goals are not met and this could possibly lead to a drop in community confidence in Council ability to delivery services and maintain/ renew community infrastructure.
· What is the likelihood of the event happening?
Low
· Adequacy of existing controls?
Adequate
· Treatment options to mitigate the risk?
Set yearly capital works program that best fits the various plan objectives, given the resources available to Council.
Conclusion
Carryover of capital works projects require Council approval as per Clause 211 of the Local Government (General) Regulation 2005.
1. Annexure
1 Murray River Council 2019-20 Budget Carryovers ⇩ ![]()
|
MURRAY RIVER COUNCIL Ordinary Council Meeting Agenda |
30 June 2020 |
File Number: -
Author: Kris Kershaw, Assistant Manager Finance
Authoriser: Ross Mallett, Director Corporate Services
|
1. That Murray River Council makes and levies the following Ordinary rates, for the 2020/2021 financial year, in accordance with s494, s.515, s.516 and s.518 of the Local Government Act 1993, and that Council adopts the 2.60% annual maximum rate peg, as approved by the Independent Pricing and Regulatory Tribunal, and that in accordance with s511 of the Local Government Act 1993, Council adopts the inclusion of the 2019/2020 notional yield $127,000 catch-up.
2. That Murray River Council makes and levies the following annual charges for Waste Management Services in accordance with s.496, s.501(1) and s.502 of the Local Government Act 1993, for the 2020/2021 financial year.
3. That Murray River Council makes and levies the following annual charges for Water Supply Services in accordance with s.501 and s.502 of the Local Government Act 1993, for the 2020/2021 financial year.
4. That Murray River Council makes and levies the following annual charges for Sewerage Services in accordance with s.501 and s.502 of the Local Government Act 1993, for the 2020/2021 financial year.
5. That Murray River Council makes and levies the following annual charges for Stormwater Management Services in accordance with s.496A of the Local Government Act 1993, for the 2020/2021 financial year.
6. That in relation to interest on overdue rates and charges, Council make and impose the maximum charge for interest of 0.00% for the period 1 July 2020 to 31 December 2020 and 7.00% per annum for the period 1 January 2021 to 30 June 2021 as determined by the Minister for Local Government, in accordance with Section 566 (3) of the Local Government Act 1993; 7. That, the 2020/21 Revenue Policy and 2020/21 Fees and Charges for the Murray River Council be adopted in accordance with s.502 of the Local Government Act 1993, and other relevant legislation as described. |
||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||
Background
At the Extraordinary Meeting held on the 19 May 2020, Council resolved to place the following 2020/21 financial year Integrated Planning and Reporting (IP&R) draft documents on public exhibition in accordance with section 405 of the Local Government Act 1993, for a period of 28 days, covering the period 22 May to 19 June 2020:
· Annexure 1 2020/21 Revenue Policy
· Annexure 2 2020/21 Fees and Charges
Exhibition of the IP&R documents was undertaken via the ‘Bang the Table’ portal and a link was also placed on Council’s own website to the portal access. Due to the current COVID-19 situation, hardcopies of documents were not made available at Council’s customer service and library centres. Advertisements were placed in various papers during the exhibition period outlining how submissions could be made to Council on the 2020/21 Revenue Policy and 2020/21 Fees and Charges.
Discussion
Revenue Policy
Under section 405 of the Local Government Act 1993, Council is required to adopt a Revenue Policy for the following financial year by 30 June each year. It is recommended that Council adopt the rates and charges based on the 2.60% maximum rate peg, as approved by the NSW Independent Pricing and Regulatory Tribunal and adopt the inclusion of the 2019/2020 notional yield $127,000 catch-up, in accordance with Sections 494, 511, 515, 516 and 518 of the Local Government Act 1993.
Council has received three (3) submissions pertaining to the 2020/21 Revenue Policy, and these are located in Annexure 3. Any further submissions received from this report date to the date of the Council meeting will be submitted to the Council Meeting on the day of the meeting. The official closing date for submissions was the 19 June 2020.
As part of the 2020/21 budget process, a rates harmonisation process was undertaken with the aim of merging the former Murray Shire and Wakool Shire Councils rating structures into one rating structure. To facilitate this process, a committee was established with community representatives to discuss and recommend a preferred rating structure. The outcome of this committee process had resulted in the proposed rating structure, as outlined in the 2020/21 Revenue Policy. This proposed rating structure was included in the exhibited 2020/21 Revenue Policy.
Rates and annual charges, with the exception of the Stormwater levy (unchanged from 2019/20 year), have been increased by the rate peg of 2.60%.
Fees and Charges
Council received no public submissions on the exhibited 2020/21 Fees and Charges. It is recommended that the Fees and charges for the services provided by the Council, as detailed in the Fees and Charges 2019/20 as attached, be adopted in accordance with Section 502 of the Local Government Act 1993.
A review of fees and charges has seen, on average, an increase of between 2.00% to 3.00%. Some fees haven’t increased at all and this can be due for reasons mainly relating to affordability or statutory. Fees and charges are a combination of statutory, partial cost recovery and full cost recovery:
· Statutory fees are set by government legislation and cannot be amended by Council.
· Partial cost recovery fees are those fees where every resident can access the service and Council only charges a partial fee to enable fair, affordable and equitable access for all residents.
· Full cost recovery fees are charged at cost to Council and are based on a user pays approach.
Strategic Implications
5 - Strategic Theme 5: Leadership and Governance
5.1 - An effective, efficient and progressive Council that provides leadership to the community
5.1.2 - Council acts in a financially responsible manner to ensure delivery of safe and sustainable services to the community
Budgetary Implications
The adoption of the 2020/21 Revenue Policy, including rates, annual charges and fees and charges allows Council to levy rates and annual charges in accordance with Council’s Delivery Program and 2020/21 Operational Plan.
Policy Implications
Nil.
The 2020/21 financial year is the first year under a new rates harmonisation process. Council was required to maintain the former Murray Shire Council and Wakool Shire Council rate structures for four years, with the final year being the 2019/2020 financial year.
Legislative Implications
Once the 2020/21 Revenue Policy and 2020/21 Fees and Charges are adopted, they will comply with the Local Government Act 1993 and all other associated Acts, Regulations and statutory requirements as stipulated in the Fees and Charges.
Risk Analysis
· What can happen?
The risks associated with the adoption of the rates and annual charges includes: Financial; Reputation; and Non-compliance with legislative requirements.
The risk assessment/rating process reveals the following risk ratings before and after control measures are implemented.
|
|
Residual Risk |
After Adoption |
|
Likelihood |
Likely |
Unlikely |
|
Consequence |
Moderate |
Minor |
|
Risk Rating |
Medium |
Low |
· How can it happen?
Refer above
· What are the consequences of the event happening?
Refer above
· What is the likelihood of the event happening?
Refer above
· Adequacy of existing controls?
Adequate.
· Treatment options to mitigate the risk?
Preparation of a fit for purpose operating plan and budget.
Conclusion
The 2020/21 Revenue Policy, including rates, annual charges and fees and charges is required to be adopted by resolution of the Council by 30 June 2020.
1. Annexure
1 2020-21 Revenue Policy ⇩ ![]()
2. Annexure
2 2020-21 Fees and Charges (under separate cover) ![]()
3. Annexure
3 Public Submissions 2020-21 Revenue Policy ⇩ ![]()
|
MURRAY RIVER COUNCIL Ordinary Council Meeting Agenda |
30 June 2020 |
8.2.6 Four Year Delivery Program, 2020/2021 Operational Plan & Budget; and 2020/21 to 2029/30 Long Term Financial Plan
File Number: -
Author: Kris Kershaw, Assistant Manager Finance
Authoriser: Ross Mallett, Director Corporate Services
|
That: 1. Council consider and note the 2020/21 budget amendments. 2. In accordance with Sections 404 and 405 of the Local Government Act 1993, Council adopt the Murray River Council 2018-2021 Delivery Program and 2020/21 Operational Plan, including the 2020/21 to 2029/30 Long Term Financial Plan. 3. In accordance with Part 9, Division 5, Section 211(2) of the Local Government (General) Regulation 2005, Council approve expenditure and capital works as detailed in the Murray River Council 2018-2021 Delivery Program and 2020/21 Operational Plan, including the 2020/21 to 2029/30 Long Term Financial Plan. |
Background
As part of the IP&R, Council is required to draft and present the Four-Year Delivery Program, the 2020/21 Operational Plan & Budget including the 2020/21 to 2029/30 Long Term Financial Plan.
At the Extraordinary Meeting held on the 19 May 2020, Council resolved to place the following 2020/21 Integrated Planning and Reporting (IP&R) draft documents on public exhibition in accordance with section 405 of the Local Government Act 1993, for a period of 28 days, covering the period 22 May to 19 June 2020:
· 2018-2021 Delivery Program and 2020/21 Operational Plan
· 2020/21 to 2029/30 Long Term Financial Plan.
Exhibition of the IP&R documents was undertaken via the ‘Bang the Table’ portal and a link was also placed on Council’s own website to the portal access. Due to the current COVID-19 situation, hardcopies of documents were not made available at Council’s customer service and library centres. Advertisements were placed in various papers during the exhibition period outlining how submissions could be made to Council the IP&R documents.
Discussion
Before the start of each financial year in July, Council must adopt an Operational Plan for the upcoming year. This plan is one document that makes up the Integrated Planning and Reporting Framework (IP&R). The Operational Plan outlines the activities and services Council plans to undertake in the 2020/21 financial year and the associated budgets to delivery those activities and services. The Operational Plan represents one year of the 2018-2021 Delivery Plan, in this case the 2020/21 year. To facilitate the activities and services, Council must adopt the expenditure items outlined in the Operational Plan.
Community Submissions
Council placed on public exhibition the IP&R documents for the 2020/21 year and received eleven (11) submissions via the ‘Bang the Table’ portal and six (6) submission via email. A list of the submissions via ‘Bang the Table’ portal and emails is attached in Annexure 4. The seventeen (17) total submissions have been received in relation to support for the Moama Pre-School development in the budget (11), road maintenance requests for the Moulamein area (3), request for works to be done in Mathoura (2) and a request for a Council employee to be based in Murray Downs (1).
Any further submissions received from the report date to the date of the Council meeting will be submitted to the Council Meeting on the day of the meeting. The official closing date for submissions was the 19 June 2020.
Council also considered four submissions as part of the draft 2020/21 Operational Plan at the Extraordinary Meeting on the 19 May 2020. A summary of the outcome of those submissions, as adopted by Council, was as follows:
· Moama Lions Club Budget Requested $75,000
Resolved to go to site and inspect with members of the Lions Club. Has been included in the 2020/21 budget.
· Koondrook/ Barham Pool Committee Budget Requested $8,500
Council resolved to increase annual contribution by $8,500. Has been included in the 2020/21 budget.
· Bridge Art Project Committee Budget Requested $45,000
Resolved by Council not to provide any funding under this request.
· Committee for Echuca Moama (C4EM) Budget Requested $not costed
Resolved by Council not to provide any funding under this request.
The final versions of the IP&R documents are as follows:
· 2018-2021 Delivery Program and 2020/21 Operational Plan attached as Annexure 1.
· 2020/21 to 2029/30 Long Term Financial Plan attached as Annexure 2.
The original draft IP&R documents presented to the Extraordinary Meeting on the 19 May 2020 presented a 2020/21 Operational Plan with an operating surplus of $3,429,498, but an overall draft deficit of ($1,179,458) once capital expenditure, reserve movements, loan borrowings and other movements are factored in.
The final IP&R documents presented to Council for adoption, as attached, present a 2020/21 Operational Plan with an operating surplus of $4,648,060, but an overall draft deficit of ($1,209,938) once capital expenditure, reserve movements, loan borrowings and other movements are factored in. Annexure 3 shows the movements to reflect operational decisions made since the original drafting of the 2020/21 Operational Plan.
The net change between the advertised draft 2020/21 Operational Plan and final 2020/21 Operational Plan is an increase to the budget deficit of ($30,480).
The recommended 2020/21 Operational Plan includes a total revised capital works program of $31,976,287, an increase of $1,447,047 on the draft budgeted capital works of $30,529,250 primarily as a result of inclusion of the Federal Government funded projects under the Local Roads and Infrastructure grant program. A full detailed listing can be found in the 2020/21 Operational Plan, as per Annexure 1.
The table on the next page shows the net budget movements in each section of the 2020/21 Operational Plan as a result of the changes listed in Annexure 3:
2020/21 Consolidated Council Comparison between Draft and Final Budgets

Strategic Implications
5 - Strategic Theme 5: Leadership and Governance
5.1 - An effective, efficient and progressive Council that provides leadership to the community
5.1.2 - Council acts in a financially responsible manner to ensure delivery of safe and sustainable services to the community
Budgetary Implications
The budget has a 2020/21 Operational Plan budget deficit of ($1,209,938) which will result in a reduction in Council’s working capital.
Policy Implications
Nil.
Legislative Implications
Local Government Act 1993 (s) 402 - 406
Risk Analysis
· What can happen?
The risks associated with this document includes: Financial; Reputation; and Non-compliance with legislative requirements.
The risk assessment/rating process reveals the following risk ratings before and after control measures are implemented.
|
|
Residual Risk |
After Adoption |
|
Likelihood |
Possible |
Unlikely |
|
Consequence |
Moderate |
Minor |
|
Risk Rating |
Medium |
Low |
· How can it happen?
Inadequate planning and budgeting.
· What are the consequences of the event happening?
Refer above.
· What is the likelihood of the event happening?
Refer above.
· Adequacy of existing controls?
Adequate.
· Treatment options to mitigate the risk?
Preparation of a fit for purpose Delivery Program, Operational Plan & Budget and Long Term Financial Plan. Also, tracking various financial ratios to ensure they meet local government benchmarks.
Conclusion
These documents set clear direction for the Council moving forward. The Delivery Program has been reviewed and updated to reflect the current goals and strategies of Council. The Operational Plan & Budget communicates to the community and other stakeholders how Council will achieve the Delivery Program goals/strategies and the Long Term Financial Plan provides the community with an understanding of how Council will operate financially over the next ten years.
1. Annexure
1 2018-2021 Delivery Program 2020/21 Operational Plan (under separate
cover) ![]()
2. Annexure
2 2020-21 to 2029-30 Long Term Financial Plan (under separate
cover) ![]()
3. Annexure
3 Changes to the 2020-21 Operational Plan Budget ⇩ ![]()
4. Annexure
4 Public Submissions 2020-21 Operational Plan (under separate
cover) ![]()
|
MURRAY RIVER COUNCIL Ordinary Council Meeting Agenda |
30 June 2020 |
8.3 Director Engineering Report & Supplementary Matters
File Number: -
Author: Jan Donald, Executive Administration Officer
Authoriser: Scott Barber, Director Engineering
Background
Correspondence received from Tanya Heffer, 532 Moulamein Road, Barham, enquiring if Council would consider selling the land (Lot 5 DP861750).
Discussion
Tanya and Graham Heffer purchased the original farming land surrounding the small piece of land that was donated to Council by the previous landholders for the Barham Rural Fire Service (RFS). The RFS constructed a small shed on the site. Prior to the amalgamation of Council, RFS relocated to a bigger shed in 2016 and the site remained the property of Council.
The site is not of any benefit to Council and requires ongoing site maintenance at a cost to the community.
Strategic Implications
1 - Strategic Theme 1: Built/Physical Environment
1.1 - Improve and maintain our built town environments
1.1.2 - Provide, maintain and improve safe, accessible footpaths, cycle and walking tracks
Budgetary Implications
The land will provide revenue based on independent valuation.
Policy Implications
Murray River Council Asset Management Policy (POL305).
Legislative Implications
Risk Analysis
· What can happen?
If Council do not dispose of unrequired or under-utilised land and or buildings, then it is funding items which are not benefiting the community.
· How can it happen?
Council reject the recommendation, or the purchaser could withdraw their offer.
· What are the consequences of the event happening?
Council would remain as landholder and need to maintain and support the site.
· What is the likelihood of the event happening?
Unlikely.
· Adequacy of existing controls?
Nil
· Treatment options to mitigate the risk?
Nil
Conclusion
The Council to approve the sale of land to the adjacent land holders – Tanya and Graham Heffer and remove the need to fund and support unrequired land and buildings.
1. Tanya
Heffer - letter of request ⇩ ![]()
2. Valuation
report - Preston Rowe Paterson ⇩ ![]()
|
MURRAY RIVER COUNCIL Ordinary Council Meeting Agenda |
30 June 2020 |
File Number: -
Author: Diane Cottrell
Authoriser: Scott Barber, Director Engineering
|
That the Council receives and notes the Officer’s report on the Major Projects Progress Update as at 18 June 2020. |
purpose
To inform elected officials and the community on the progress of externally funded “one-off” major projects.
PROJECT – UPDATES
The contracted building works are nearly complete for the Moulamein Pre-School and the Moama Recreation Reserve Pavilion (excl. grandstand seating), with Barham Recreation Reserve Pavilion handover expected 30 June 2020. This will soon close out works under the Stronger Community Fund Round 1. Additional works are in progress under different funding streams to finalise these projects.
The Barham Community Hub has entered the normal defect stage, as building works are now complete under the Stronger Country Community Fund Round 1 with landscaping and paving in progress to complete this project.
The footbridges and bike paths at Mathoura Picnic Point are also complete with the project under final review before close out.
At the end of May, the Smart Water Meters project reported 3,381 smart water meters and 10 receiver towers installed with the second receiver tower in Moama making good progress. The percentage installation complete to date is as follows: 80% Mathoura, 89% Moama, 42% Moulamein and 15% Barham. Customers are already realising the benefits of the smart water meters through the early detection, notification and rectification of previously undetected leaks.
The evaluation of the tender submissions for the new Enterprise Resource Planning System is complete and Council will receive a recommendation on the preferred supplier for Council approval. This was a 9-month, information gathering and evaluation process, engaging with representatives from each business unit who participated in “deep dives” with each tenderer, development of the business specifications, tender documentation and evaluation. Next step is to finalise the contract pending Council approval to complete the procurement stage.
Council is re-engaging with consultants and contractors to re-think delivery of remaining project that have been delayed by COVID 19 restrictions, how best to consult with community and how we remain safe as restrictions ease. Council is reviewing the overall impact on our timeline obligations under the various grant Funding Deeds and preparing time extension requests to submit to the funding bodies where required.
The table below shows the status of the Major Projects. Twenty of the thirty-eight projects are complete and the remainder on track with the exception of Barham Pontoon, which has an extension approved by the funding body.
|
Stage |
SCF1 |
SCF2 |
SCCF1 |
SCCF2 |
RGF1 |
MRC |
TOTAL |
|
Number of projects |
9 |
7 |
7 |
7 |
6 |
2 |
38 |
|
Start-up |
|
1 |
|
|
|
|
3% |
|
Scoping |
|
|
|
|
1 |
|
3% |
|
Design |
|
|
|
|
3 |
|
8% |
|
Planning |
|
|
|
|
|
|
0% |
|
Procurement |
|
1 |
|
|
|
|
3% |
|
Construction |
3 |
1 |
1 |
4 |
2 |
1 |
31% |
|
Complete |
6 |
4 |
6 |
3 |
|
1 |
52% |
|
Summary |
|
||||||
|
% in progress |
33% |
43% |
14% |
57% |
100% |
100% |
|
|
% complete |
66% |
57% |
86% |
43% |
0% |
0% |
|
|
Variation to budget of the 18 completed projects |
|||||||
|
% under budget |
80% |
86% |
71% |
100% |
n/a |
n/a |
|
|
% over budget* |
20% |
14% |
29% |
0% |
|
||
*Council holds uncommitted funds within each of the funding streams to allocate to budget variations within the same stream, which provides a degree of flexibility to manage project budgets. Council funds any variations to scope on Council funded projects, such as the Moama HQ.
|
MURRAY RIVER COUNCIL Ordinary Council Meeting Agenda |
30 June 2020 |
|
Program Status – Stronger Communities Fund Round 1 (SCF1) |
SCF1 $9,000,000 OTHER $703,606 |
Projects 9
|
||
|
|
|
|
|
|
|
|
||||
|
Status On track Stage Construction Budget $3,965,000 SCF1 Actual $$ 87% - SCF1 |
Status On track Stage Construction Budget $2,000,000 SCF1 $100,000 AFL $200,000 SCCFR3 Actual $$ 100% SCF1 19% OTHER |
Merran Creek Bridge
Stage Closure Budget $525,000 SCF1 $342,000 MRC Actual $$ 100%
- SCF1 |
Tooleybuc Mensforth Park
Status On track Stage Construction Budget $650,000 SCF1 $300,000 RGF1 Actual $$ 100%
- SCF1 |
Mathoura Rec Reserve
Stage Closure Budget $516,000 SCF1 $44,436 MRC Actual $$ 100% - SCF1 100% - MRC |
|
Barham Rec Reserve
Stage Closure Budget $407,000 SCF1 Actual $$ 100% SCF1
|
Moulamein Pre-School
Stage Defect stage Budget $396,000 SCF1 $150,480* Actual $$ 100% - SCF1 100% - MRC *SCF1 underspent project funds |
Moulamein South Rec Reserve
Stage Closure Budget $360,812 SCF1 Actual $$ 100% SCF1 |
Mathoura Picnic Point Reserve
Status Complete Stage Closure Budget $200,000 SCF1 Actual $$ 100% SCF1 |
|
|
Comments: Moama Recreation Reserve Stage
1 - Pavilion: Building works 100%
complete. Defects itemised for rectification. Landscaping, civil works and
fit out in progress. Stage 2 – Grandstand: Building Works 100%
complete and ahead of schedule. Stadium seating procured awaiting installation.
Landscaping to front in progress. NB: funding has been repurposed from underspends within the SCF1 funding stream to cover overspends and now 100% utilised. |
||||
|
Program Status – Stronger Communities Fund Round 2 (SCF2) |
SCF2 $4,095,000 MRC $32,157 |
Projects 7 |
||
|
|
|
|
|
|
|
|
||||
|
MRC Culture / Bus Excellence F/work / Enterprise System
Stage Delivery Budget $1,500,000 SCF2 Actual $$ 10% - SCF2 |
Stage Start-up Budget $1,195,000 SCF2 Actual $$ 0% - SCF2 |
Moama Business Park Upgrade Water Pressure Pump
Stage Procurement Budget $500,000 SCF2 Actual $$ 27% - SCF2 |
Moama Council New Office
Stage Closure Budget $250,000 SCF2 Actual $$ 100% - SCF2 |
Status Complete Stage Closure Budget $250,000 SCF2 $32,157 MRC Actual $$ 96% |
|
Status Complete Stage Closure Budget $200,000 SCF2 Actual $$ 96% |
Status Complete Stage Closure Budget $200,000 SCF2 Actual $$ 83% |
Comments: MRC ERP evaluation complete and recommendation of preferred supplier with Council. Revised Business Culture Improvement program received for consideration and approval. Business Excellence program being re-scheduled. Extension of time request in progress. Moama Business Park Pump Upgrade: On track to complete 16 July 2020 - no delays or issues Exceptions: Moama Business Park expansion: Scope variation and extension of time request in progress |
||
|
Program Status – Stronger Country Communities Fund Round 1 (SCCF1) |
SCCF1 $2,049,463 MRC $54,891 RGF1 $530,000 |
Projects 7
|
||
|
|
|
|
|
|
|
|
||||
|
Status Under investigation Stage Construction Budget $505,000 SCCF1 Actual $$ 69% - SCCF1 |
Tooleybuc Pontoon
Stage Construction Budget $505,000 SCCF1 $330,000 RGF1 Actual $$ 100%
- SCCF1 fund |
Status Complete Stage Closure Budget $384,294 SCCF1 Actual $$ 70% - SCCF1 |
Murray Downs Path Stage 1
Stage Closure Budget $80,960 SCCF1 Actual $$ 96% - SCCF1 |
Tooleybuc Rec Reserve
Stage Closure Budget $120,206 SCCF1 $40,794 MRC Actual $$ 100% - SCCF1 100% - MRC |
|
Moulamein Swimming Pool
Stage Closure/defect Budget $133,975 SCCF1 $14,097 MRC Actual $$ 104% - SCCF1 100% - MRC |
Barham, Bunnaloo, Koraleigh, Mathoura, Wakool Courts
Actual $$ 91% |
Comments: Barham Pontoon: New gangway design criterion agreed and design in progress, expected 9 July 2020 followed by fabrication. Due for completion 23 July. Tooleybuc Pontoon: Remaining works reported under RGF1 funding. |
||
|
Program Status – Stronger Country Communities Fund Round 2 (SCCF2) |
SCCF2 $2,624,555
|
Projects 7
|
||
|
|
|
|
|
|
|
|
||||
|

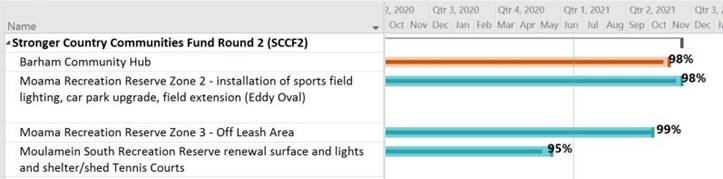

Barham Community Hub Stage 1
Stage Construction Budget $828,411 SCCF2 Actual $$ 90% |
Moama Rec Reserve Zone 2
Stage Construction Budget $736,411 SCCF2 Actual $$ 95% |
Moama Rec Reserve Zone 3
Stage Construction Budget $266,1025 SCCF2 Actual $$ 86% |
Moulamein South Rec Reserve
Stage Construction Budget $347,310 SCCF2 Actual $$ 80% |
Murray Downs
Stage Defect stage Budget $174,023 SCCF2 Actual $$ 68% |
|
Tooleybuc Mensforth Park
Stage Closure Budget $117,023 SCCF2 Actual $$ 73% |
Playgrounds
Stage Defect stage Budget $255,473 SCCF2 Actual $$ 81% |
Comments: Barham Community Hub: Building works 100% complete, defect rectification underway, landscaping and external paving in progress. Moama Recreation Reserve Zone 2: defect rectification complete. Awaiting confirmation of funding reallocation to expand scope of works. Zone 3 – opened and operational. Bin enclosures to come to complete project. Moulamein South Recreation Reserve: Slab poured and shed in final stages of construction due for completion by end of June. Further scoping underway. |
||
|

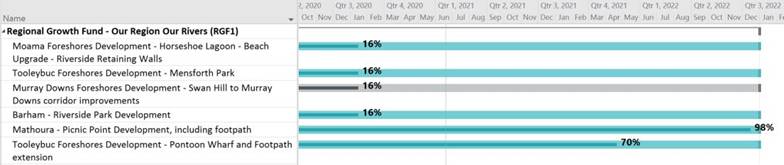

Program Status – Regional Growth Fund (Our Region our Rivers) (RGF1) 50/50 funding with MRC/SCF1/SCCF1&2 |
RGF1 $2,007,696 MRC $751,271 |
Projects 6
|
||
|
|
|
|
|
|
|
|
||||
|
Moama Foreshore Horseshoe Lagoon, Beach Amenities Block and Riverside Retaining Wall
Stage Design and approval Budget $751,271 RGF1 $751,271 MRC Actual $$ 0% |
Tooleybuc Foreshore
Stage Design and approval Budget $300,000 RGF1
Actual $$ 40% - RGF1 |
Murray Downs Foreshore
Stage Design and approval Budget $117,925 RGF1
Actual $$ 4% |
Barham Riverside Park
Stage Scope Budget $171,000 RGF1 Actual $$ 0% |
Mathoura Picnic Point
Stage Construction Budget $137,500 RGF1 Actual $$ 100% - RGF1 |
|
Tooleybuc Foreshore Pontoon
Stage Construction Budget $330,000 RGF1 $505,000 SCCF1 acquitted Actual $$ 38% - RGF1 |
Comments: Moama Foreshore - Horseshoe Lagoon and Riverside Retaining Wall: to commence FY2020-21 Beach Amenities Block: Drafting of Specification for procurement of Removable toilet unit (similar to MacLean’s Beach Deniliquin adopted). Drafting RFQ for water and sewerage, and power design. Further progress to commence FY2020-21 Tooleybuc Mensforth Park: Recommence activities and conduct community consultation on final design following relaxing of restrictions Murray Downs Foreshore: Recommence activities and conduct community consultation on final design following relaxing of restrictions Barham Riverside Park: Design of the erosion protection system in progress for riverbank immediately upstream of the wharf. Mathoura Picnic Point: Footbridges and bike path complete. Review and close out project Tooleybuc Pontoon: Septic Tank design complete. Installation will commence once power connection is approved |
|||
|
MRC – Moama Office Refurbishment MRC – Smart Water Meter Replacement Program
|
MRC $6,024,305
|
Projects 2
|
||||
|
|
|
Actual Spend /Budget |
|
|
||
|
|
||||||
|
Water Meter Replacement Program
Stage Construction Budget $2,900,000 MRC1 $1,224,305 MRC2
Actual $$ 30% |
Moama HQ refurbishment
Stage Defect stage Budget $1,700,000 MRC $200,000 MRC
Actual $$ 100% |
UAT conducted. MiWater (remote) training completed and participants’ certificates issued. 2nd Moama receiver installation underway. June water billing activities scheduled and in progress. Leakages identified through automated readings from new smart meters installed and customers notified, leakages investigated and rectified. NB: Actual Spend over total budget dropped due to the increase in budget by $1,224,305 |
||||
|
MURRAY RIVER COUNCIL Ordinary Council Meeting Agenda |
30 June 2020 |
The last Major Projects report for this financial year is ending on a high with many projects closed, funds acquitted and entering the new financial year with a big bang, as we reschedule dormant projects and schedule new projects.
Nil
|
MURRAY RIVER COUNCIL Ordinary Council Meeting Agenda |
30 June 2020 |
File Number: -
Author: Jan Donald, Executive Administration Officer
Authoriser: Scott Barber, Director Engineering
|
That Council approve the reduction of the Perricoota Road speed limit from 80 kilometres per hour to 60 kilometres per hour from the end of the existing 50km/hr at the Moama Recreation Reserve to 24 Lane, Moama. |
Background
At the Ordinary Meeting of Council on 25 February 2020, council rejected a Local Traffic Committee recommendation to reduce the current 80 kilometres per hour (km/h) zone all the way to 24 Lane and instead, amended the recommendation to reduce the speed to 60km/h to the Winbi roundabout.
Discussion
The recent approval at the May Ordinary Meeting of Council for development of 368 lots along Beer Road and 24 Lane, south of the Rich River Golf Course, has prompted the Local Traffic Committee to revisit the original recommendation to Council.
Also, as mentioned in previous reports to Council and associated discussions;
· Traffic Counts along Perricoota Road have increased from 5200 (2012) to 7000 (2019) vehicles per day (vpd).
· There are 13 entrances onto Perricoota Road from other roads, residences and resorts;
|
Tindarra Resort |
Lakeview Drive |
273 Perricoota Road |
|
13 Perricoota Road |
Sugar Gums Drive |
Brolga Ave |
|
Charters Drive |
Winbi Avenue |
Murray River Resort |
|
Lignum Road |
Merlot Blvd |
Cadell Resort |
|
|
|
24 Lane |
· On Merool Road there are four commercial businesses; the Moama RSL Club, Morrison’s Winery/Function centre, Merool Holiday Park and Discovery Parks (Moama West).
· On Winbi Avenue there is the Winbi Holiday Resort
· On 24 Lane there are a number of vehicles travelling to the Rich River Golf Club, some of these people may now use the newly sealed Beer Road.
· Pedestrians cross the road at Winbi Avenue roundabout, Charters Drive, Lignum Road, Lakeview Drive and Merool Road for bus and path access.
· Crash analysis (2013-18): 0.32 casualties per km – typical rural road for 80km/hr is 0.115; therefore 2.78 times higher than the average rate of accidents – alcohol, speed, fatigue; 6 accidents
· Growing residential developments along the Perricoota Road including Winbi, Dungala, Murray Bank, Riversands and Lakeview with a total of 589 lots. Approximately half of these lots are yet to construct homes which will access Perricoota Road
· The newly approved 368 residences will use 24 Lane and Perricoota Road or Beer Road to travel into Moama and Echuca.
· Increased pedestrian traffic which includes school children from the newly developed area.
· Perricoota Road crossing by school children in the morning and in the afternoon to catch school buses
Forecast Vehicles Numbers
Assumptions:
· 680 houses to be constructed along Perricoota Road, 24 Lane and Beer Road at this time.
· Each new home will have at least 1 car and undertake a minimum of 2 return trips per day along Perricoota Road, potentially see a further 1,300 vpd to a total of 8,300 vpd.
· Using typical road designer assumptions of 10 vehicle movements per day or 5 return trips, all using Perricoota Road, traffic counts could increase to a total to 9,200 vpd.
Excluded - unable to quantify the impacts of traffic counts at this time;
· Traffic counts for the approved school to be constructed on Lignum Road
· Traffic counts for the proposed pre-school along Lignum Road.
· Expected development along Merool Road, Lignum Road, Beer Road and Perricoota Road west of 24 Lane
Strategic Implications
1 - Strategic Theme 1: Built/Physical Environment
1.1 - Improve and maintain our built town environments
1.1.2 - Provide, maintain and improve safe, accessible footpaths, cycle and walking tracks
Budgetary Implications
Approximately $5,000 for signage and labour.
Policy Implications
Murray River Council Asset Management Policy (POL305).
Murray River Council Vehicle Crossings Policy (POL301).
Legislative Implications
Roads Transport Act 2013.
Roads Act 1993.
Risk Analysis
· What can happen?
Increasing vehicular traffic in the developing areas along Perricoota Road will potentially increase the safety risk for both pedestrians and road users.
· How can it happen?
Collisions with cars, pedestrians or cyclists due to increased volume of traffic and other users on the roads.
· What are the consequences of the event happening?
Risk to public safety, increasing change of death or serious injury.
· What is the likelihood of the event happening?
High likelihood if vehicles continue to speed along Perricoota Road and children continue to cross without assistance to bus stops and otherwise.
· Adequacy of existing controls?
Low
· Treatment options to mitigate the risk?
Reduce the speed limit from the current 80km/h to 60km/h.
Conclusion
Traffic and pedestrian safety needs to be addressed along Perricoota Road based on the current and future traffic counts, number of separate entrances onto the road, relatively high accident rate and recent approval to development 386 lots on 24 Lane and Beer Road.
A reduction of the Perricoota Road speed limit to 60km/h from the current 50km/hr zone heading north west to 24 Lane, would reduce the highest risks for bus stops, pedestrians, cyclists and other traffic for now and expected growth in the foreseeable future.
1. Local
Traffic Committee Minutes ⇩ ![]()
|
MURRAY RIVER COUNCIL Ordinary Council Meeting Agenda |
30 June 2020 |
8.4 Director Planning, Waste & Regulatory Services Report & Supplementary Matters
File Number: -
Author: Melanie Squires, Strategic Planner
Authoriser: David Wilkinson, Director Planning, Waste & Regulatory Services
|
That Council 1. Adopt the final Murray River Council Local Strategic Planning Statement. 2. Approve staff to send the statement onto the Department of Planning, Industry and Environment for endorsement. |
Background
In March 2018, amendments to the Environmental Planning and Assessment Act 1979 (the EP&A Act) introduced a new requirement for all NSW local councils to prepare and make a Local Strategic Planning Statement (LSPS). Section 3.9 of the EP&A Act requires that the LSPS include or identify the following:
· the basis for strategic planning in the area, having regard to economic, social and environmental matters
· the planning priorities for the area that are consistent with any strategic plan applying to the area and (subject to any such strategic plan) any applicable community strategic plan under section 402 of the Local Government Act 1993
· the actions required for achieving those planning priorities
· the basis on which the Council is to monitor and report on the implementation of those actions.
The broad planning priorities and outcomes described in the LSPS influence Council’s detailed planning controls and guide future changes to Council’s Local Environmental Plan (LEP), Development Control Plan (DCP) and other plans which implement the actions in the LSPS. The LSPS was to be endorsed by the Department of Planning, Industry and Environment (DPIE) by June 30 2020, however, will now be sent for endorsement as soon as adoption by Council occurs. The LSPS was sent to DPIE for comment during the consultation process. No issues were identified. Staff do not foresee any issues associated with endorsement.
Discussion
The LSPS sets out the 20-year vision for land use planning in Murray River Council, outlining how growth and change will be managed to encourage economic growth, and maintain the high levels of environmental amenity, liveability and landscape quality that characterises our area. It identifies the special characteristics that contribute to Murray River Council’s local identity and recognises the shared community values to be maintained and enhanced.
This Statement identifies nine (9) Planning Priorities to achieve the Council’s vision for the area, together with actions and the means for monitoring and reporting on the delivery of the actions. It is consistent with the NSW Government’s strategies and plans for land use planning in the Riverina Murray – the Riverina Murray Region Plan and the Murray Regional Economic Development Strategy – and is aligned with the Murray River Council Community Strategic Plan 2018-2028. Planning staff held targeted forums in early October 2019 which sought preliminary feedback regarding key issues effecting planning and land use in Murray River Council. This feedback was used in conjunction with the aforementioned regional and local strategic plans to shape the draft LSPS.
The priorities of the LSPS were formed to achieve three (3) key outcomes relating to our economy, liveability, and environment. Table 1 below outlines the key themes and priorities driving the LSPS:
|
THEME 1 A robust, growing and innovative economy |
Priority 1 – Grow, strengthen and sustain agriculture |
|
Priority 2 – Grow and strengthen tourism |
|
|
Priority 3 – Create an ‘open-for-business’ identity |
|
|
THEME 2 Liveable communities with social capital |
Priority 4 – Housing growth, supply and density |
|
Priority 5 – Recreation and open space |
|
|
Priority 6 – Servicing and utility infrastructure |
|
|
THEME 3 Environment, heritage and climate change |
Priority 7 – Identify and protect environmental values |
|
Priority 8 – Celebrate culture and heritage |
|
|
Priority 9 – Climate change and natural hazards |
At the Council meeting held 24 March 2020, Council resolved to:
· Provide approval of the Draft Murray River Council Local Strategic Planning Statement.
· Proceed to public consultation for the Draft Local Strategic Planning Statement in accordance with the approved Communication and Engagement Plan.
Due to the COVID-19 crisis restrictions in place at the time the draft was exhibited, Council could not engage as originally planned with physical community workshops and information sessions. All consultation for this draft was subsequently carried out online, largely via the Your Say Murray River Portal. The draft was publicly exhibited from 26 March 2020 until 29 April 2020 via a variety of online and print media. Council received a fantastic level of community engagement to the draft document. A post-consultation update was presented at the Council meeting held 26 May 2020. The submissions and accompanying report were noted by Council.
Staff have now considered the feedback received during the exhibition period and the statement has been finalised. The Final LSPS is largely the same as the draft document with relevant minor changes. The three (3) Themes and nine (9) Planning Priorities remain unchanged.
Since the May Council meeting, a collation of responses from government agencies have also been received. The ideas presented were largely covered by the draft LSPS already however minor amendments were made in the final statement, where appropriate. Many of the comments were very specific, and as such the appropriate actions within those responses have been flagged to be considered when preparing the specific strategies resulting from the LSPS (e.g. housing strategy, climate change risk assessment, riverfront development strategy etc.).
To improve readability and visual aesthetic, the final LSPS was professionally edited and subject to graphic redesign. The intent and outcomes of the LSPS has been unaffected through this process.
The projected timeline for completion of the LSPS and associated Local Environmental Plan presented at the March Council meeting has generally been met. As noted at the time of the draft LSPS due to the nature of the project, there may be some unanticipated delays. The external editing process took longer than anticipated and the date of the June Council meeting being pushed back meant that the deadline for DPIE endorsement (30 June) could not be met. DPIE are aware that the LSPS is up for adoption at this Council meeting and will be ready to review and endorse once Council adoption is confirmed.
· LEP Review and Health Check - Completed October 2019
· Draft ‘Vision’ LSPS chapter- Completed and heard at October 2019 Council meeting
· Completed draft LSPS –December 2019 Council meeting (confidential)
· Draft LSPS available to public - March 2020 Council meeting
· Exhibition of Draft LSPS seeking community feedback – from late March 2020 to approximately mid-May 2020 (minimum of 28 calendar days)
· Post exhibition review - Review of submissions –May 2020
· Finalise LSPS– completed and presented at June Council meeting
· Submission of LSPS to DPIE for endorsement – immediately following Council adoption
Strategic Implications
1 - Strategic Theme 1: Built/Physical Environment
1.1 - Improve and maintain our built town environments
1.1.1 - Support each township to develop their unique character
Budgetary Implications
The Final LSPS recommends a number of studies, strategies and actions to be undertaken to inform the strategic directions and priorities. Examples of such strategic investment include (but are not limited to):
· The development of a Riverfront Land Strategy to inform the future land use of the riverfront (moorings, housing, and tourism).
· The development of Housing Strategies to inform the growth of our towns;
· Investigations to inform rural land use and in particular, changes to land uses to enable growth, sustainability, and resilience of our agricultural sector;
· Potential investment into new multi-purpose facilities to attract large scale sporting and recreation events to our Council area;
· Biodiversity investigation to inform updated mapping;
· Climate Change Risk Assessment;
· Meninya Street revitalisation.
The aspirations of the LSPS proposed to be driven and funded by Council will require considered discussion regarding the allocation of budget and potential utilisation of funding allocated to Council as part of the amalgamation process.
Policy Implications
Murray River Council Economic Development Assistance Policy (POL600).
Murray River Council Events Policy (POL402).
Legislative Implications
Environmental Planning & Assessment Act 1979.
Local Government Act 1993.
Murray Local Environmental Plan 2011
Wakool Local Environmental Plan 2013
Risk Analysis
· What can happen?
If Council fails to adopt a LSPS by June 30, 2020, Council will not meet the requirements of the EP&A Act.
· How can it happen?
Council delays action on the LSPS and fails to meet the stipulated deadlines.
· What are the consequences of the event happening?
Council will be in breach of the EP&A Act and DPIE will create an LSPS on our behalf.
· What is the likelihood of the event happening?
Very low, due to the draft LSPS having been approved and the intent and outcomes remaining unchanged in the final statement.
· Adequacy of existing controls?
Council is working towards the deadlines in place, in close partnership with DPIE. The controls are deemed adequate.
· Treatment options to mitigate the risk?
Council support the resolution to adopt the Final LSPS and approve staff to send the final statement onto DPIE for endorsement.
Conclusion
The LSPS is a 20-year strategic planning document informing the land use planning and development of Murray River Council. The final LSPS captures priorities and actions to deliver positive economic, social and environmental outcomes for Murray River Council. It is recommended that Council adopt the final Murray River Council LSPS to enable staff to send the statement to DPIE for endorsement as soon as possible.
1. Final
Murray River Council Local Strategic Planning Statement (under separate cover) ![]()
|
MURRAY RIVER COUNCIL Ordinary Council Meeting Agenda |
30 June 2020 |
File Number: -
Author: Llyan Smith, Senior Town Planner
Authoriser: David Wilkinson, Director Planning, Waste & Regulatory Services
|
That the Officer’s report on Finalisation of Planning Proposal to rezone Part Lot 52 DP 1220883 Boundary Road, Moama as at 8 May 2020 be received and the information noted by the Council.
|
Discussion
On 26th February 2019, Council resolved to endorse a Planning Proposal effecting part Lot 52 DP 1220883, Boundary Road, Moama to:
· Rezone from E3 Environmental Management Zone to R2 Low Density;
· Amend the minimum lot size requirements from 120 hectares to 1000m2.
While a report represented at the Council meeting held 28 April 2020 failed to pass any resolution, legal advice obtained confirmed that the original resolution of support stands. The planning proposal was not changed since the original support was issued, and the current Gateway required that the proposal be finalised by 19 May 2020. Staff relied on the original resolution from 26th February 2019 to complete this amendment of the Murray Local Environmental Plan 2011 (Murray LEP 2011).
This report is presented to confirm that the Planning Proposal has now been finalised. The amended Murray LEP 2011 was gazetted on 8 May 2020, and is now in effect.
A timeline of this proposal is provided here, for reference:
|
Planning Proposal draft submission |
May 2016 |
|
Comments and further information requested |
10 May 2016 |
|
Finalised Planning Proposal lodged |
12 May 2016 |
|
Council resolved to support Planning Proposal and send to Department of Planning Industry & Environment (DPIE) for Gateway Determination |
28 June 2016 |
|
Planning Proposal sent to DPIE requesting Gateway Determination |
5 July 2016 |
|
Gateway Determination issued by DPIE |
12 August 2016 |
|
Additional information requested from Applicant in accordance with Gateway Determination conditions |
22 August 2016 |
|
Gateway extension issued (until 12 August 2018) |
15 August 2017 |
|
Amended Planning Proposal submitted to Council for checking |
20 November 2017 |
|
Amended Planning Proposal forwarded to DPIE for checking and comment |
25 January 2018 |
|
Request sent to DPIE for extension of time to complete |
25 January 2018 |
|
Gateway extension issued (until 19 February 2019) |
6 February 2018 |
|
Response from DPIE re Planning Proposal assessment |
12 July 2018 |
|
Amended Planning Proposal heard at Council meeting (deferred to February 2019 Council Meeting) |
22 January 2019 |
|
Gateway extension issued (until 19 February 2020) |
1 February 2019 |
|
Amended Planning Proposal heard at Council meeting (supported ) |
26 February 2019 |
|
Planning Proposal forwarded to DPIE seeking amended Gateway |
17 April 2019 |
|
Amended Gateway issued to Council approving Delegation and confirmation issued to proceed to community consultation |
6 May 2019 |
|
Referral to relevant agencies in accordance with Gateway Determination conditions |
21 May 2019 |
|
NSW Biodiversity Conservation Division (formerly Office of Environment & Heritage - OEH) response received |
12 June 2019 |
|
Community consultation |
6 August 2019 – 4 September 2019 |
|
Advertised in local newspaper (Riverine Herald) |
7 August 2019 |
|
Registration of scar tree with Aboriginal Heritage Management Systems (AHIMS) |
22 August 2019 |
|
Roads & Maritime Services (RMS) response (as neighbour submission) |
5 September 2019 |
|
Request from Council to DPIE for extension of time sent to complete LEP |
15 January 2020 |
|
Gateway extension issued (until 19 May 2020) |
4 February 2020 |
|
Mapping and executed Map Cover Sheet sent to DPIE for checking (via portal) |
6 April 2020 |
|
Confirmation issued by DPIE that mapping and associated documents were acceptable |
14 April 2020 |
|
Draft LEP requested from Parliamentary Counsel’s Office (PCO) |
15 April 2020 |
|
Draft LEP received from PCO |
24 April 2020 |
|
Confirmation of Draft LEP to PCO |
27 April 2020 |
|
PCO opinion requested |
27 April 2020 |
|
PCO opinion received |
30 April 2020 |
|
LEP finalised |
5 May 2020 |
|
Final LEP sent to Department of Planning Industry & Environment requesting notification |
5 May 2020 |
|
LEP adopted and notified |
8 May 2020 |
|
MURRAY RIVER COUNCIL Ordinary Council Meeting Agenda |
30 June 2020 |
File Number: -
Author: David Wilkinson, Director Planning, Waste & Regulatory Services
Authoriser: David Wilkinson, Director Planning, Waste & Regulatory Services
|
That the Planning, Waste & Regulatory Services Directorate - Monthly Activity Report for the period 1 May to 31 May 2020 be received and the information noted by the Council. |
Discussion
This report details the activities of Council’s Planning, Waste & Regulatory Services Directorate from 1 May to 31 May 2020.
1. Applications

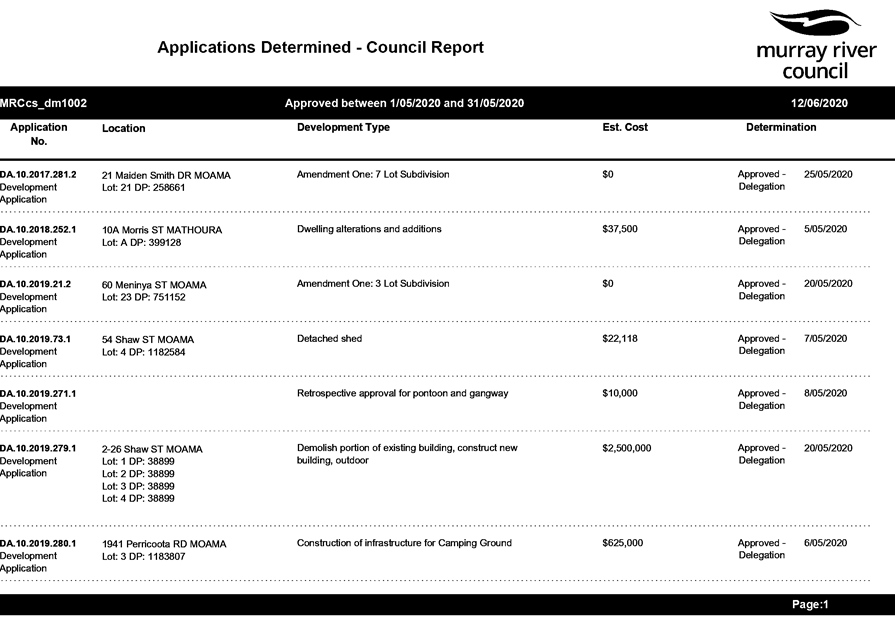

Determined under Delegated Authority - 1 May to 31 May 2020 ⇩ ![]()
2. Application
Key Performance Summary – Outstanding Applications May 2020 ⇩ ![]()

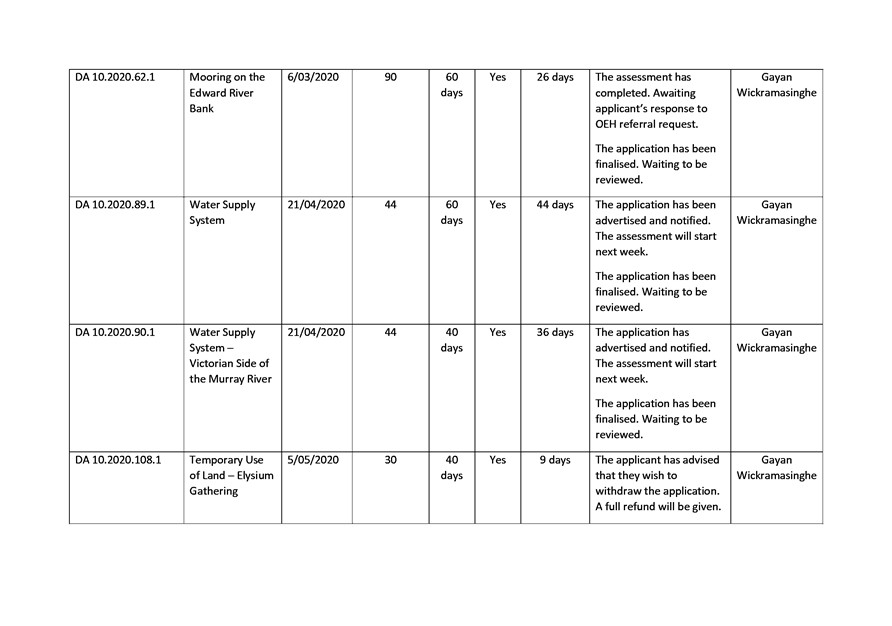

3. DA
Performance Report - May 2020 ⇩ ![]()

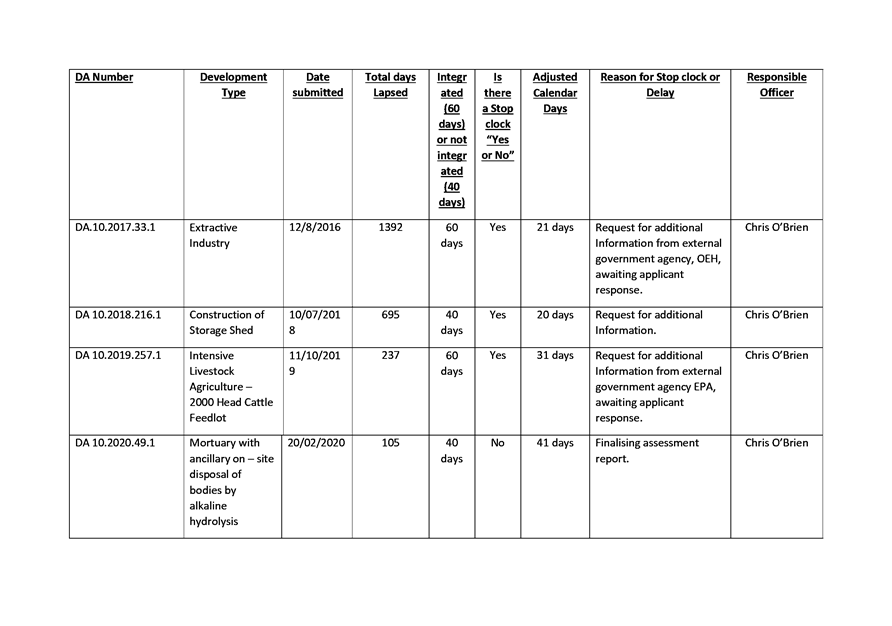

4. Compliance
Report - May 2020 ⇩ ![]()
5. Waste
Report - May 2020 ⇩ ![]()
6. Local

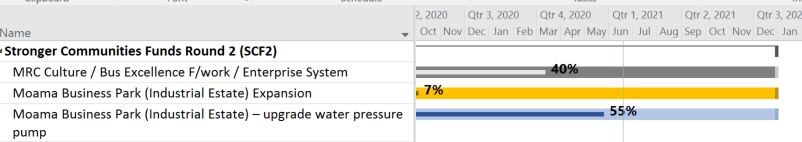

Strategic Planning Statement Project Results ⇩ ![]()
|
MURRAY RIVER COUNCIL Ordinary Council Meeting Agenda |
30 June 2020 |
File Number: -
Author: Rosemarie Lewandowski, Administration Officer Project
Authoriser: Des Bilske, General Manager
|
That the Correspondence Report be received and the information noted by the Council. |
Discussion
01/06: Local Government NSW Weekly
Newsletters dated 16 June,12 June, 5 June, and 29 May, have been forwarded to Councillors and Management Executive via email.
02/06: Australian Local Government Association (ALGA) News
Newsletters dated 5 June, 29 May have been forwarded to Councillors and Management Executive via email.
16/06: Forwarding a Media release from The Hon Mark Coulton MP – Minister for Regional Health, Regional Communications and Local Government re: Rural Health Commissioner Office extended to improve rural healthcare.
16/06: Local Government NSW
Forwarding a Council Circular dated 16 June 2020 re: further relaxation of restrictions on attendance at council and committee meetings during the COVID-19 pandemic.
12/06: Local Government NSW
Forwarding a Media Release dated 12 June 2020 re the postponement of elections allowing councils to focus on critical issues facing their communities.
05/06: Local Government NSW
Forwarding a Media Release dated 5 June 2020 re the introduction of permits for non-desexed cats and dangerous/restricted dogs.
04/06: Local Government NSW
Forwarding a COVID 19 Council update.
03/06: Local Government NSW
Forwarding a Council Circular dated 3 June 2020 - 2020 Clarification for issuing and collecting 2020-21 single and first quarter rates instalments.
02/06: Local Government NSW
Forwarding a COVID 19 Council update.
01/06: Local Government NSW
Forwarding a COVID 19 Council update
29/05: Local Government NSW
Forwarding a COVID 19 Council update.
29/05: Local Government NSW
Forwarding a Media Release dated 29 May 2020 - Australian councils unite in push for seat at the national decision-making table.
29/05: Local Government NSW
Forwarding a Media Release dated 29 May 2020 - LGNSW announces new chief executive.
28/05: Murray Darling Basin Bulletin
Forwarding Murray Darling Basin Bulletin dated 28 May 2020.
05/06: Thank you letter – Operation Bindii
Enclosed letter of thanks from Janet Cincotta after receiving a voucher of $250.00 to remove thousands of Bindii from laneways and roadsides.
12/06: Thank you letter – Moulamein Business Centre – Sandy Peeters
Enclosed letter of thanks from Sandy Peeters for keeping the Moulamein Business centre open.
.
1. Media
Release re: Rural Health Commissioner Office extended to improve rural Healthcare
⇩ ![]()
2. Council
Circular 16 June - Further relaxation of restrictions on attendance at council
and committee meetings during the COVIC-19 pandemic ⇩ ![]()
3. Media
Release: re postponement of elections allowing councils to focus on critical
issues facing their communities ⇩ ![]()
4. Media
release: re the introduction of permits for non-desexed cats and
dangerous/restricted dogs ⇩ ![]()
5. COVID-19
Council Update 4 June 20 ⇩ ![]()
6. Council
Circular 20-20 re: Clarification for issuing and collecting 20-21 single and
first quarter rates instalments ⇩ ![]()
7. COVID-19
Council Update 2 June 20 ⇩ ![]()
8. COVID-19
Council Update 1 June 20 ⇩ ![]()
9. COVID-19
Council Update 29 May 20 ⇩ ![]()
10. Media
release re: Australian councils unite in push for seat at the national decision
making table ⇩ ![]()
11. Local
Government NSW announces new Chief Executive ⇩ ![]()
12. Murray
Darling Basin Bulletin Issue 34 ⇩ ![]()
13. Thank
you letter re: Operation Bindii - Janet Cincotta ⇩ ![]()
14. Thank
you letter re: Moulamein Business Centre - Sandy Peeters ⇩ ![]()
|
MURRAY RIVER COUNCIL Ordinary Council Meeting Agenda |
30 June 2020 |
File Number: -
Author: Rosemarie Lewandowski, Administration Officer Project
Authoriser: Des Bilske, General Manager
|
That the Sundry Delegates Report of the Mayor and Councillors for the period 26 May 2020 to 29 June 2020 be received and the information noted by the Council; and reasonable out of pocket expenses be met by Council. |
Discussion
The Mayor, Councillor Chris Bilkey reported on his attendance at the following meetings and functions:
· 27 May: Phone interview with Edge FM
· 27 May: Meeting with Charles Sturt University – zoom meeting
· 28 May: Phone interview with 3SH
· 28 May: Local Traffic committee meeting
· 3 June: Councillor briefing session and RAMJO Presentation on Water position
· 4 June: Stakeholder Engagement meeting – Berrigan
· 10 June: Phone interview with Edge FM
· 10 June: Echuca Moama Tourism board meeting
· 11 June: Murray Regional Leadership meeting
· 12 June: Meeting with landowners re: Ethanol plant
· 17 June: Councillor briefing session
· 18 June: Regional Australia – zoom meeting
· 24 June: Regional Australia Institute Webinar
· 30 June: Pre-Council briefing
· 30 June: Ordinary meeting of Council
The Deputy Mayor, Councillor Alan Mathers reported on his attendance at the following meetings and functions:
· 26 May: Councillor workshop & Ordinary Council meeting
· 3 June: Online Council update re COVID-19 and other matters
· 4 June: RAMJO water policy meeting – Berrigan
· 9 June: Albury Hilltop accommodation proposal at Moama
· 17 June: Councillor briefing session – RAMJO Water position paper
· 19 June: MRSG combined Board and Water policy group meeting – Deniliquin
· 24 June: Councillor briefing session
· 30 June: Pre-Council meeting
· 30 June: Ordinary meeting of Council
Councillor Tony Aquino reported on his attendance at the following meetings and functions:
· 26 May: Councillor workshop & Ordinary Council meeting
· 12 June: Meeting on site re: Ethanol plant
· 17 June: Site visit to Mathoura boat ramp upgrade
· 17 June: Councillor briefing session – RAMJO Water position paper – MS Teams
Councillor Gen Campbell reported on her attendance at the following meetings and functions:
· 26 May: Councillor workshop & Ordinary Council meeting
· 27 May: Lions meeting @ War Street
· 28 May: Long Paddock meeting
· 28 May: Local Traffic meeting
· 03 June: Councillor briefing session
· 09 June: Councillor briefing session
· 17 June: Councillor briefing session – RAMJO Water position paper – MS Teams
· 24 June: Councillor briefing session
· 30 June: Councillor workshop & Ordinary Council meeting
Councillor Nikki Cohen reported on her attendance at the following meetings and functions:
· 26 May: Public Forum and Councillor briefing
· 27 May: Ordinary Council meeting
· 3 June: Councillor update meeting - MS Teams
· 9 June: Meeting with Minister of Agriculture and Western New South Wales, Mr Adam Marshall – Moama
· 17 June: Councillor briefing session – RAMJO Water position paper – MS Teams
· 17 June: Councillor update meeting – MS Teams
· 24 June: Councillor update meeting – MS Teams
Councillor Ann Crowe reported on her attendance at the following meetings and functions:
· 26 May: Councillor workshop & Ordinary Council meeting – MS Teams
· 2 June: Adverse Event Plan – zoom meeting
· 17 June: Councillor briefing session and RAMJO Presentation on Water position
Councillor Neil Gorey reported on his attendance at the following meetings and functions:
· 3 June: Councillor briefing session
· 9 June: Councillor briefing session
· 15 June: National Timber Councils association general meeting.
· 17 June: Councillor briefing session – RAMJO Water position paper – MS Teams
· 24 June: Councillor briefing session
Councillor Thomas Weyrich reported on his attendance at the following meetings and functions:
No report provided
Councillor Geoff Wise reported on his attendance at the following meetings and functions:
· 26 May: Smart Meter briefing
· 26 May: Council pre briefing & Ordinary meeting of Council
· 27 May: War street re: Lions units
· 28 May: Met ratepayer re footpath on Holmes Street Moama
· 9 June: Meet Minister Marshall (Minister for Agriculture and Western NSW)
· 9 June: Briefing re Rates harmonisation and Budget
· 15 June: Mathoura Retirement Village
|
MURRAY RIVER COUNCIL Ordinary Council Meeting Agenda |
30 June 2020 |
|
MURRAY RIVER COUNCIL Ordinary Council Meeting Agenda |
30 June 2020 |
