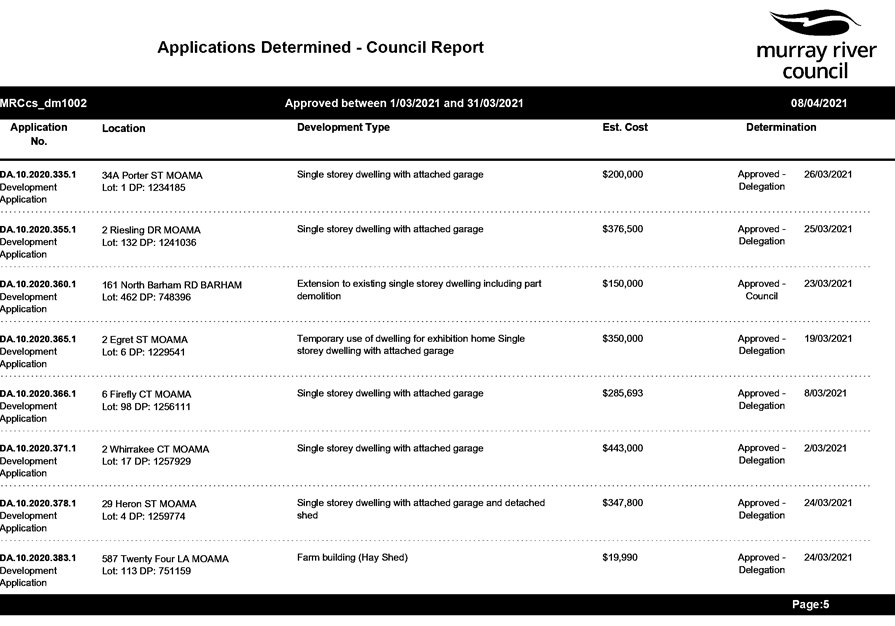

9.4.1 Planning & Environment Directorate - Monthly Activity Report
9.4.2 Murray River Council Draft Companion Animal Breeding Policy - Post Consultation Update
9.5 Director Community and Economic Development Report and Supplementary Matters
9.5.1 Code of Conduct Policy - Vulnerable Persons and Children
9.5.2 Murray Downs Community Garden
9.5.3 Grant Funding Report - April 2021
9.5.4 Section 355 Committee Reports - April 2021
9.5.5 Community Services locations - 2021-22 proposed community access and standardised fees
9.5.6 Murray River Council and Lions Club of Moama - Memorandum of Understanding
10 Notice of Motions/Questions with Notice
10.3 Notice of Motion -That Council investigate the cost of purchasing a street sweeper
10.4 Notice of Motion - firebreaks in Murray River Council rural areas
11.2 Tender MRC 2101 Design & Construction of Barham Micro Abattoir
MURRAY RIVER COUNCIL Ordinary Council Meeting Agenda |
27 April 2021 |
File Number: -
Author: Lindy Leyonhjelm, Executive Assistant
Authoriser: Terry Dodds, Chief Executive Officer
That the minutes of the Ordinary Meeting of Murray River Council held on 23 March 2021 be confirmed as a true and correct record. |
Discussion
Murray River Council held its Ordinary Meeting of the Council on Tuesday 23 March 2021, commencing at 2:00pm in the Council Chambers (Lower Level), Moama Administration Office, 52 Perricoota Road, Moama.
A copy of the draft minutes is attached for ratification by the Council at this meeting.
1. MINUTES

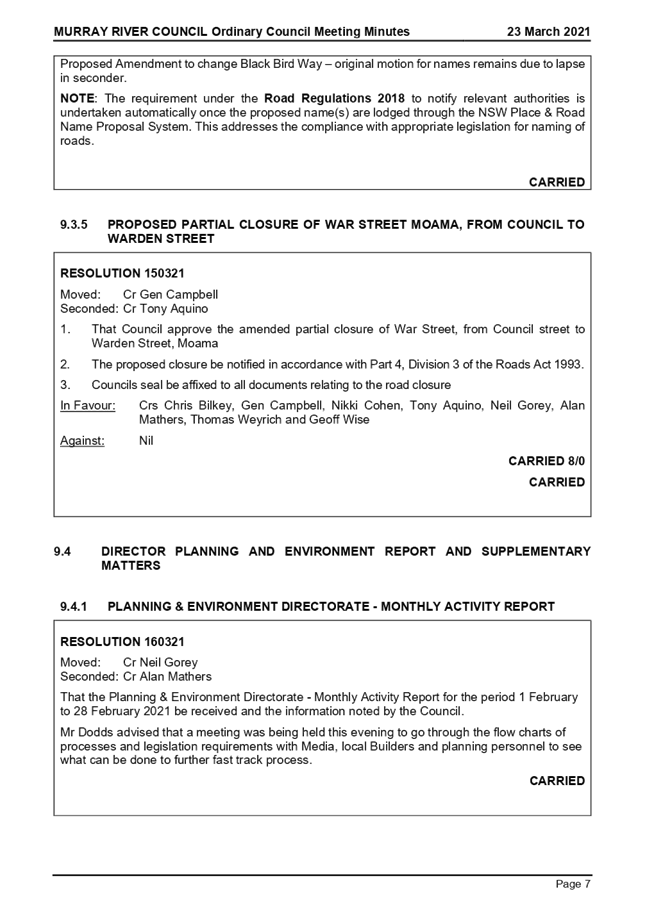

_ Ordinary Council Meeting of Murray River Council 23 March 2021 ⇩
MURRAY RIVER COUNCIL Ordinary Council Meeting Agenda |
27 April 2021 |
At this stage of the meeting, being 2.05pm, a letter written by The Hon. Emma Hurst MLC, Animal Justice Party will be read out by the Mayor Cr Chris Bilkey regarding Item [11.1 shown in Confidential Matters] of the Report - [DA No. 10.2020.121.1].
At this stage of the meeting, being 2.10pm, Debra Tranter (Submission Maker from Oscars Law) will make a deputation to the Council regarding Item [11.1 shown in Confidential Matters] of the Report - [DA No. 10.2020.121.1].
At this stage of the meeting, being 2.15pm, Matt Johnson, Senior Planner, Habitat Planning will make a deputation to the Council on behalf of the applicant regarding Item [11.1 shown in Confidential Matters] of the Report - [DA No. 10.2020.121.1].
MURRAY RIVER COUNCIL Ordinary Council Meeting Agenda |
27 April 2021 |
9.1 Chief Executive Officers Report and Supplementary Matters
File Number: -
Author: Lindy Leyonhjelm, Executive Assistant
Authoriser: Terry Dodds, Chief Executive Officer
That the Council receives and notes the status of previous resolutions of Council (in open and closed Council) contained in the Resolution Tracker Reports. |
Background
In September 2018 a manual Resolution Tracker was introduced as part of the General Manager’s report to each Council meeting to allow Councillors to review the current status (actions by Council’s officers) of their decisions (resolutions).
All resolutions within the manual Resolution Tracker have been completed by Council’s officers and will be archived. Subsequently, the manual Resolution Tracker has been superseded by the InfoCouncil Action Report.
In November 2018, Council introduced a software program called InfoCouncil. Resolutions of the Council that require action/s after each Council Meeting are automatically generated in InfoCouncil to the relevant Council officer for their action and comment.
Discussion
The Resolution Tracker Open Report (Attachment 1) and the Resolution Tracker Closed Action Report (Attachment 2) contain ‘active’ resolutions respectively from open and closed meetings of the Council held since November 2018 that require action by Council’s officers.
Comments for the action are shown below each active resolution of the Council. Resolutions that are reported by Council’s officers as complete will drop off the ‘active’ list.
Strategic Implications
5 - Strategic Theme 5: Leadership and Governance
5.1 - An effective, efficient and progressive Council that provides leadership to the community
5.1.1 - Council decision making takes into account the needs and priorities of our local communities and the longer term social, cultural, economic and environmental viability and sustainability of our region
Budgetary Implications
Nil.
Policy Implications
Nil.
Legislative Implications
Nil.
Risk Analysis
· What can happen?
Council’s officers do not action the resolutions of the Council.
· How can it happen?
Resolutions from Council Meetings not being recorded in a systematic fashion.
· What are the consequences of the event happening?
Actions, because of the resolutions of the Council, not being completed in a timely manner or at all.
· What is the likelihood of the event happening?
Low.
· Adequacy of existing controls?
Use of the report and minute system, InfoCouncil, which automatically forwards actions (as a result of the resolutions of the Council) from Council Meetings to the relevant Council officer (report writer) after the completion of the minutes of a Council Meeting. A report can then be generated on the status of incomplete/outstanding actions.
· Treatment options to mitigate the risk?
Due diligence undertaken by Council’s officers (administration and report writers).
Conclusion
The Resolution Tracker and Action Reports are presented to Councillors for information.
1. RESOLUTION
TRACKER - CLOSED_ 27 APR 2021 ⇩
2. V2
RESOLUTION TRACKER - OPEN_ 27 APR 2021 ⇩
MURRAY RIVER COUNCIL Ordinary Council Meeting Agenda |
27 April 2021 |
9.2 Director Shared Services Report and Supplementary Matters
File Number: -
Author: Abbas Mehr, Financial Accountant
Authoriser: Terry Dodds, Chief Executive Officer
That the Officer’s report on FINANCIAL STATEMENTS AND INVESTMENTS AS AT 31 MARCH 2021 be received and the information noted by the Council. 1. The report detailing the Council’s Position of $ 49,773,531.17 as at 31st March 2021 is received. 2. The report detailing Council’s Investment balance of $ 48,037,859.69 as at 31st March, 2021 received.
|
background
Discussion
REPORT – BANK RECONCILIATION
Shown below are the Financial Statements, Bank Reconciliations and Investments for the period ending 31st March 2021.

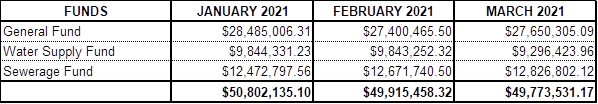

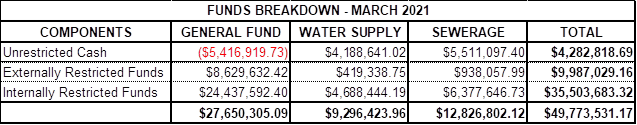

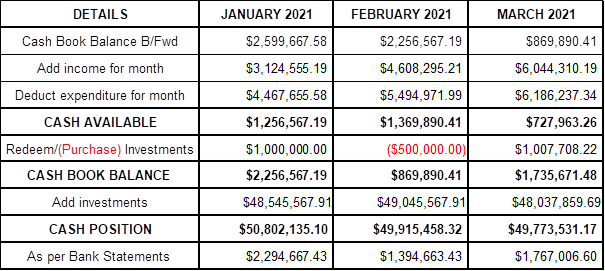

STATEMENT OF BANK BALANCES AS AT 31st MARCH 2021 OF COUNCIL’S COMBINED ACCOUNTS
INTERNAL CASH BOOK BALANCES
OVERDRAFT LIMITS: Bank Overdraft - $ 650,000.00
I hereby certify that the Cashbook of the various funds of Council has been reconciled, with the appropriate Pass Sheets as 31st March 2021.
Terry Dodds
Chief Executive Officer / Acting Director Shared Services

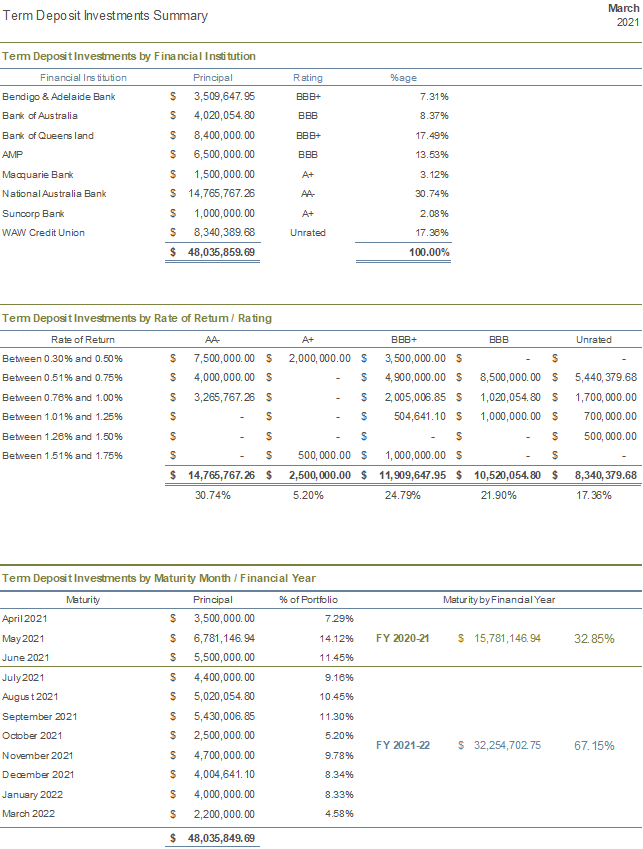

REPORT INVESTMENTS AS AT 31st MARCH 2021
As required by Section 212 of the Local Government (General) Regulation 2005 and Section 625 of the Local Government Act 1993, the details of Council’s surplus funds invested, totalling $48,037,859.69 are listed below.
STRATEGIC IMPLICATIONS
5 – Strategic Theme 5: Leadership and Governance
5.1 – An effective, efficient and progressive Council that provides leadership to the community.
5.1.2 – Council acts in a financially responsible manner to ensure deliver of safe and sustainable services to the community.
BUDGETARY IMPLICATIONS
Continual low interest rates may have a negative impact on the expected interest value.
POLICY IMPLICATIONS
Investments are made in accordance with the Council’s Investment Policy which was adopted on
the 27 October 2020
LEGISLATIVE IMPLICATIONS
Section 625 of the Local Government Act 1993
Regulation 212 of the Local Government (General) Regulations 2005
Trustees Act 1925 Section 14
RISK ANALYSIS
· What can happen?
Imprudent use of council’s financial resources
· How can it happen?
Not following investment rules, policies or mandates
· What are the consequences of the event happening?
Potential loss of financial resources
· What is the likelihood of the event happening?
Low
· Adequacy of existing controls?
Good
· Treatment options to mitigate the risk?
Responsible management of financial resources invested in accordance with Council’s investment policies and mandate.
CONCLUSION
Murray River Council’s liquidity is in a satisfactory position at 31st March 2021.
MURRAY RIVER COUNCIL Ordinary Council Meeting Agenda |
27 April 2021 |
9.3 Director Operations and Major Projects Report and Supplementary Matters
File Number: -
Author: Matthew Sherman, Project Coordinator
Authoriser: Scott Barber, Director Operations & Major Projects
That the Officer’s report on Major Projects Progress Update as at 12 April 2021 be received and the information noted by the Council. |
Purpose
To inform elected officials and the community about the progress of externally and internally funded major infrastructure projects.
Discussion
Major Projects currently manage the delivery of 44 projects across Murray River Council including community infrastructure, strategic assets, water services and transport network projects. All projects continue to be delivered on time and within budget, with several projects approaching final stages of completion across Council.
Major Projects also commenced 2021/22 budget planning and preparation, project prioritisation and alignment with the Community Strategic Plan - Improved Built and Physical Environment (Theme 1). Major Projects maintains its partnership with Community and Economic Development Team to secure available external funding opportunities, and to meet our reporting obligations to further strengthen our positive relationship with funding providers.
Major Road Projects Victoria - Echuca / moama BridGe update
· Precast concrete “Super-Tee” beams were installed on all remaining Victorian bridge approach spans to the Murray River and were installed for the NSW flood relief structure.
· Concrete bridge deck pours have been completed for the Campaspe River Bridge, with barriers to be installed in coming months. Concrete bridge deck pours have also commenced on the bridge approach spans to the Murray River.
· Assembly of the large travelling form machines for construction of the main span of the Murray River is underway, with installation to occur in April. Segmental construction of the main span will commence at this time.
· Construction of pavement, drainage and shared user paths continue. Topsoiling of earthworks batters has commenced along with construction of noise wall foundations on the Victorian side.
PRoject Highlight Report – Bridges

Murray River Council continues to maintain its long-term commitment to our improved built and physical environment being well planned, connected, safe and designed to support our communities, industries, and businesses. As part of this commitment, Council has progressively replaced old timber bridges that are no longer safe or functional for today’s requirements. Council gratefully secured funding through the NSW Fixing Country Bridges Program to replace all remaining 5 timber bridge projects in the next two years.
One active timber bridge replacement project is the construction of the Nacurrie Road North / Middle Creek Bridge, shown in the photos below.
Funded under the Australian Government's Local Roads and Community Infrastructure Program, once complete this bridge will provide surrounding communities and businesses year-round access.
Photos in the ‘before’ section show the previous state of the bridge, with ‘construction’ photos showing works progress. The Nacurrie Road North / Middle Creek Bridge has now completed the pouring of the concrete deck and is anticipated to finish 2 months ahead of schedule.
Before Construction: During
Construction:
Major Projects also has an additional 8 Bridge Projects currently in progress listed below with a summary of project progress.
Nearest Town |
Location |
Status |
Gonn |
Drysdale Lane/Merran Creek Bridge |
Site Surveying and Geotechnical Investigation complete. Drafting of tender documentation in progress. Construction to be completed by 30/06/2023 for all Bridges. |
Barham |
Sandys Road/Barber Creek Bridge |
|
Neimur |
Frasers Road/Murrain Yarrein Creek Bridge |
|
Mallan |
Tooranie Road/Yarrein Creek Bridge |
|
Mellool |
Nacurrie Road South/Merran Creek Bridge |
Precast beams, piles, headstocks, and abutments are awaiting site delivery and installation. Project expected to be completed by 30/06/2021. |
Moulamein |
Moulamein-Swan Hill Road (MR386)/Yarrein Creek Bridge |
On the Market for Tender. Contracted will be awarded for construction to commence 1/07/2021. |
Burraboi |
Rangemore Road/Jimaringle Creek Bridge |
Precast beams, piles, headstocks, and abutments complete. Site works yet to commence. On track for delivery 31/07/2021. |
Moulamein |
Moulamein-Barham Road (MR319)/Edward River Bridge |
Bridge repairs expected to commence 30/04/2021 and are anticipated to be completed by the 30/06/2021. |
MURRAY RIVER COUNCIL Ordinary Council Meeting Agenda |
27 April 2021 |

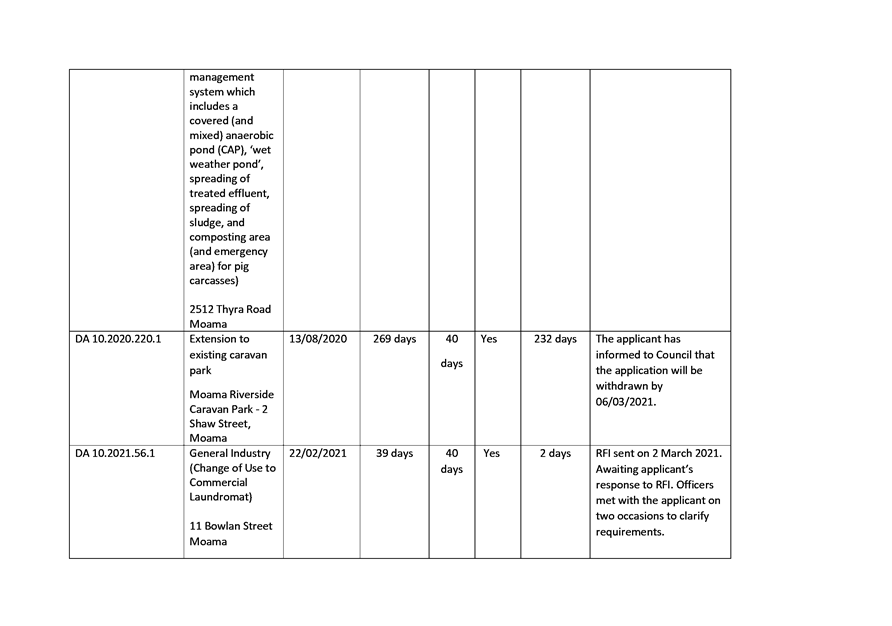

Please refer to the image below highlighting project updates:
Location |
Project Title |
Project Manager |
Project Phase |
% Works Complete |
Status |
Total Cost |
% Spent |
Comments |
Barham |
Recreation Reserve Multi-Sports Pavilion - Stage 1 & 2 |
LK |
Construction |
98% |
On Track |
$2,538,241 |
99% |
SCCF3 funds approaching completion. Outstanding works: Car Park completion & Landscaping. |
Barham |
Barham Recreation Reserve |
LK |
Delivered |
95% |
On Track |
$197,727 |
94% |
Entry box and Parkman Avenue entrance completed. Lighting installed. Internal road upgrades in progress. Community BBQ procured. Expected delivery 4 weeks. |
Barham |
Riverside Park Development |
OM |
Preliminary Design |
16% |
On Track |
$171,000 |
0% |
Designs complete. Agency consultation in progress. Next steps: Request for quotation for construction. |
Moama |
Business Park (Industrial Estate) Expansion |
BG |
Approval |
40% |
On Track |
$1,195,000 |
51% |
Land Acquired from RRGC. Gas main extension completed. Currently creating scope for subdivision design works. Request for quotation for design to be released once complete. |
Moama |
Recreation Reserve Zone 2 - installation of sports field lighting, car park upgrade, field extension (Eddy Oval) |
LK |
Delivered |
98% |
On Track |
$764,963 |
93% |
New entry design completed. Works expected to commence within 2 weeks. Lighting defects continue to be rectified by contractor. |
Multiple |
Facilitate Active Participation in Recreation |
LK |
Original Scope Complete - additional work Progress. |
100% |
On Track |
$370,765 |
102% |
Initial scope of work completed for Project. Variation to include additional works approved. Barham Recreation Reserve footpath complete. All works now completed except Moulamein netball courts due to base layer failure. Final Reports to be completed and submitted to GMO Office. |
Moama |
Foreshores Development |
OM |
Preliminary Design |
15% |
On Track |
902,542 |
3% |
Foot bridge design consultants appointed and foot bridge design in progress. Request for quotation for review of environmental factors delivered to market. |
Moama |
Foreshores Development |
OM |
Procurement |
15% |
On Track |
$200,000 |
11% |
Designs to be completed week ending 17/04/2021. Tender documentation ready for review upon receiving design documentation. Review of environmental factors has progressed. Responses from Aboriginal Land Council and Heritage NSW have been slow. |
Moama |
Foreshores Development |
OM |
Preliminary Design |
10% |
On Track |
$400,000 |
0% |
Design Consultants appointed. Design now in progress. Request for quotation for review of environment delivered to the market. |
Multiple |
Wakool Recreation Reserve Playground, |
LK |
Original Work Complete - Variation Approved |
100% |
On Track |
$212,308 |
98% |
Approval for variation to scope to add for Moulamein South Rec Reserve for pedestrian crossing and lighting approved by Grants Management Office - Department of Regional NSW. Funding Deeds signed and returned. |
Murray Downs |
Exercise track/footpath and equipment |
LK |
Delivered |
95% |
On Track |
$174,023 |
67% |
Pathway construction from Kidman Reid Drive to Swan Hill Rd to commence. Procurement completed and contractor appointed. |
Tooleybuc |
Mensforth Park Upgrade |
LK |
Construction |
95% |
On Track |
$860,000 |
81% |
Procurement complete. Contractor appointment commenced. Reviewing available budget and scope of works prior to commencement of works. Construction expected to begin within two weeks. |
Wakool |
Wakool Recreation Reserve |
LK |
Delivered |
97% |
On Track |
$220,909 |
0% |
All works complete. Awaiting final invoices to complete final reporting to funding bodies. |
Roads, bRidges, Assets & Water
Please refer to the image below highlighting project updates:
Location |
Project Title |
Project Manager |
Project Phase |
% Works Complete |
Status |
Total Cost |
% Spent |
Comments |
Wakool |
Rehabilitation and widening MR94 (Wakool Road) |
FG |
Construction |
100% |
On Track |
$840,000 |
51% |
Sealed 2.0km. Line marking outstanding |
Hollins |
Hollins Lane - 8km to 9km |
FG |
Construction |
15% |
On Track |
$1,260,000 |
5% |
Construction commenced. |
Barham |
Barham-Deniliquin/Barham Road |
FG |
Construction |
90% |
On Track |
$6,223,367 |
77% |
Construction in progress. On track to be completed mid-June 2021. |
Moama |
Seal - 24 Lane |
FG |
Construction |
30% |
On Track |
$882,000 |
10% |
Construction of the first 1.0km will be completed by mid-April 2021. |
Barham |
Seal - Cincotta Lane |
FG |
Construction |
75% |
On Track |
$240,000 |
75% |
In progress - Work will be completed by mid-April 2021. |
Moama |
Seal - Gilmour Road |
FG |
Construction |
36% |
On Track |
$1,152,000 |
23% |
First 1.5km of road seal completed. The rest will be completed during 21/22 financial year. |
Noorong |
Noorong Road Widen Shoulders |
FG |
Construction |
100% |
On Track |
$345,000 |
85% |
Construction completed. Line marking outstanding. |
Bunnaloo |
Bunnaloo Road Widen Shoulders |
FG |
Construction |
35% |
On Track |
$223,050 |
22% |
Construction underway. Work to be completed by 23 April 2021. |
Moulamein |
Moulamein-Barham Road (MR319)/Edward River Bridge |
OM |
Approval |
15% |
On Track |
$295,000 |
0% |
Due to complete repairs by 30th June 2021. Scheduled for commencement of repairs by 30/04/2021.
|
Mellool |
Nacurrie Road North / Middle Creek Bridge |
OM |
Construction |
75% |
On Track |
$500,000 |
8% |
Concrete Deck Poured on 12/04/2021. Project on track to be completed by 30/04/2021 ahead of scheduled completed date 30/06/2021. |
Mellool |
Nacurrie Road South / Merran Creek Bridge |
OM |
Construction |
15% |
On Track |
$500,000 |
0% |
Construction work on site commences on 19/04/2021. Beams, piles, precast headstocks, and precast abutments have been cast and ready to deliver to site. On schedule for delivery by 30/06/2021. |
Moama |
Construct Lignum Road |
FG |
Construction |
50% |
On Track |
$680,000 |
37% |
Construction will be completed by mid-April 2021. |
Water |
Smart Water Meter Replacement Program - Stage 1 & 2 |
JB |
Construction |
75% |
On Track |
$4,124,305 |
69% |
Raw meter installed for previously unmetered communities currently underway. Barham approaching completion, once completed Moulamein install will commence. |
Multiple |
Crown land - Develop Plans of Management |
LK |
Construction |
10% |
On Track |
$92,888 |
0% |
Works with CT Management on-going. |
LGA |
Aerial Imagery Capture |
BG |
Delivered |
100% |
On Track |
$167,000 |
100% |
Works completed. |
LGA |
Transport Asset Condition Assessment & Valuation |
BG |
Construction |
90% |
On Track |
$529,910 |
86% |
Works continuing - all raw data now received, currently finalising revaluation |
LGA |
Building, Land, Facility & Plant Assessment |
BG |
Procurement |
50% |
On Track |
$442,888 |
36% |
Works continuing - Building and plant data collection now complete, currently finalising data set and moving on to valuation and reporting component |
Mathoura |
Picnic Point |
OM |
Preliminary Design |
10% |
On Track |
$360,000 |
6% |
Detailed design in progress following conclusion of the review of the design by Council and community. Next: Tenders for construction |
Murray Downs |
Murray Downs Foreshore |
OM |
Planning & Permits |
10% |
On Track |
$920,000 |
1% |
Procurement of consultancy services in progress. Next step: Detailed design |
Burraboi |
Rangemore Road/Jimaringle Creek Bridge |
OM |
Construction |
10% |
On Track |
$735,000 |
6% |
Beams, piles, precast headstocks, precast abutments complete. Site works yet to commence. On schedule for delivery 31/07/2021. |
Gonn |
Drysdale Lane/Merran Creek Bridge CR |
OM |
Preliminary Design |
10% |
On Track |
$70,000 |
5% |
Site Surveying Complete. Geotechnical investigation complete. Drafting of Tender Documentation in progress. Tenders to be issued by end of June 2021. Construction to be completed by 30/06/2023 |
Barham |
Sandys Road/Barber Creek Bridge CR |
OM |
Preliminary Design |
10% |
On Track |
$70,000 |
5% |
|
Neimur |
Frasers Road/Murrain Yarrein Creek Bridge CR |
OM |
Preliminary Design |
10% |
On Track |
$70,000 |
5% |
|
Mallan |
Tooranie Road/Yarrein Creek Bridge CR |
OM |
Preliminary Design |
10% |
On Track |
$70,000 |
4% |
Major Projects completed in the last 24 months
Location |
Project Title |
Construction Complete |
Barham |
Community Hub – Stage 1 |
July 2020 |
Barham |
Recreation Reserve Skate Park |
March 2019 |
Barham |
Bridge Road Access |
December 2019 |
Barham |
Riverside Park Development – Pontoon |
October 2020 |
Barham |
Lawson Pavilion Refurbishment 1-2 |
February 2021 |
Mathoura |
Recreation Reserve Pavilion Ext, Kitchen & Bar |
May 2019 |
Mathoura |
Picnic Point Development (footbridges) |
June 2020 |
Mathoura |
Picnic Point Boat Ramp |
July 2020 |
Moama |
Recreation Reserve Zone 4 Lights / Criterion Track/ Landscape |
March 2019 |
Moama |
New Office Car Park Upgrade |
December 2019 |
Moama |
Recreation Reserve Road Sealing and Drainage |
December 2019 |
Moama |
HQ refurbishment Stage 1 |
January 2020 |
Moama |
Rec Reserve Zone 2 – Installation of sports field lighting, car park upgrade, field extension (Eddy Oval) |
August 2020 |
Moama |
Rec Reserve Zone 3 – Off Leash Area |
August 2020 |
Moama |
Moama Recreation Reserve – Showground Stimulus Funding |
October 2020 |
Moama |
Business Park (Industrial Estate) – Water Pump Upgrade |
January 2021 |
Moulamein |
Merran Creek Bridge - Moulamein-Swan Hill Road |
June 2020 |
Moulamein |
Pre-School |
October 2020 |
Moulamein |
South Rec Reserve renewal surface and lights and shelter shed / Tennis courts |
June 2020 |
Tooleybuc |
Recreation Reserve Irrigation System Upgrade |
January 2020 |
Tooleybuc |
Foreshores Development - Pontoon |
November 2019 |
Tooleybuc |
Mensforth Park Footpath and Lighting |
November 2019 |
Tooleybuc |
Mensforth Park Upgrade Stage 1 |
March 2020 |
Tooleybuc |
Recreation Reserve Amenities Building |
October 2020 |
Wakool |
New Toilet Block |
July 2020 |
Wakool |
Ezy Dump installation – Wakool Recreation Reserve |
February 2021 |
Various |
Playgrounds – Wakool Rec Reserve, Moulamein South Rec Reserve, Tooleybuc Mensforth Park, Moama Adventure Playpark, Wakool Township Exercise Equipment |
July 2019 |
CONCLUSION
All projects in progress remain on track for delivery within set timeframes and approved budgets. Council continues to maintain its pace in securing available funding in addition to undertaking planning and approvals for future projects in alignment with Council and Government strategic priorities.
MURRAY RIVER COUNCIL Ordinary Council Meeting Agenda |
27 April 2021 |
File Number: -
Author: Scott Barber, Director Operations & Major Projects
Authoriser: Terry Dodds, Chief Executive Officer
That Council; 1. Note that Essential Energy will be replacing 1,311 halogen luminaires with Light Emitting Diodes (LEDs) within Murray River Council 2. Agree to retain decorative lights where already installed; and 3. Pay Essential Energy costs upfront and start collecting savings upon program completion. |
Background
Essential Energy (EE) owns 165,000 streetlights, across 85 regional councils, of which 20% are already Light Emitting Diode (LED). EE is working with Councils to replace 90% of the non-LEDs under their Bulk Lamp Replacement (BLR) program by 2024.
In late 2018, a LED tender was undertaken by EE to provide a range of LED luminaries to replace an estimated 98% of the existing non-LED technology streetlights within the 2019-2024 regulatory period. A significant benefit from the EE tender process was the improvement in quality of product and reduction in energy consumption that has further improved the value of LED compared to older technology.
The Southern Lights Group of 42 Councils, included in the procurement process an option for ‘Smart ready’ LED’s including an extra zhaga port, enabling the addition of small sensors to support ‘Smart Cities’ applications.
The Southern Lights Street Lighting project is a collaborative initiative across the Canberra Region Joint Organisation, Central NSW Joint Organisation, RAMJO, REROC including Broken Hill, Balranald and Wentworth Councils. Its goal was the deployment of 75,000 smart-ready LED streetlights commencing in late 2019 and expected to be completed by late 2022.
Figure 1: Southern Lights NSW
https://southernlightsnsw.org.au/
LED is the latest technology in energy efficient lighting. A Light Emitting Diode is a semiconductor device that converts electricity into light.
A LED light uses almost 5 times less energy than a standard Halogen globes and lasts over 7 times longer. The total life cycle operating cost of LED luminaries is significantly lower than retaining the existing technology when considering both maintenance and energy savings.
Further, LED’s provide more uniform and reliable lighting creating safer public spaces for the community, and reduced greenhouse emissions into the environment.
This saves energy and money plus reduces the number of globes ending up in landfill.
Discussion
This Essential Energy LED Upgrade Program has accelerated Council conversions to LED technology. Essential Energy has scheduled the 6-week upgrade of 1,311 LED luminaires at Murray River Council around September-October 2021.
A LED luminaire is the complete lighting unit consisting of light emitting elements with parts for light distribution, position and protection, and to connect the unit to a branch circuit.
Light Replacement Options:
1. Basic replacement after rebates is in the rage of $542,000-$600,000 and projected annual power savings of $91,000.
2. Replacement retaining decorative lights in various parts of the towns, costing within the range of $664,000-$720,000 (MRC revised figure) and savings are $84,000/yr.

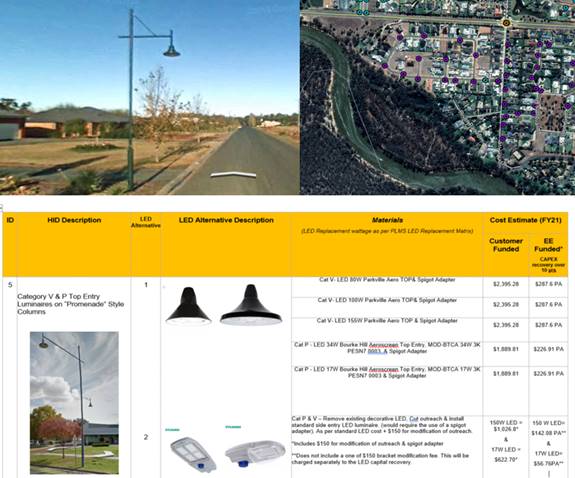

Figure 2: Decorative Lights
Table 1: Essential Energy LED upgrade estimates - costs, savings and environmental benefits
Residential Lift Costs |
Number of lights |
Total Payable to EE* |
Net CAPEX to Council |
Annual Saving |
Greenhouse Gas Saved (tCO2-e/MWh) |
Carbon Saving Equivalent cars on the road |
Retain Decorative Lights |
1311 |
$800,000 |
$744,000 |
$83,820 |
256 |
112 |
Basic Lights |
1311 |
$665,000 |
$601,000 |
$91,210 |
293 |
128 |
*Added 10% contingency to Essential Energy’s cost estimates
Strategic Implications
1 - Strategic Theme 1: Built/Physical Environment
1.2 - Improve and maintain our road and transport network
1.2.1 - Develop long-term plans for maintenance and construction of town streets and the rural road network - with priorities established in conjunction with the community
Budgetary Implications
After discussion with Finance, Council should budget $800,000, as the estimated costs from Essential Energy have varied from $689,000 to $720,000 so far.
Council will receive a rebate in the order of $56,000 from Essential Energy once the upgrade is complete and ongoing savings of at least $84,000 per year. The return on investment is approximately 11.3% per annum.
Costs will be refined closer to the installation by Essential Energy.
Council Payment Options;
1. Council can pay upfront; or
2. Council do not pay upfront and track Essential Energy using savings to pay the difference for 10 years.
Albury City Council has paid upfront, to avoid a decade of administration and checking that the power distributer (Essential Energy) is recouping the right savings, and so they could realise savings immediately.
Policy Implications
Murray River Council Asset Management Policy (POL305).
Legislative Implications
Risk Analysis
· What can happen?
Council and Essential Energy continue to use halogen street lighting technology.
· How can it happen?
Lights are not updated to LED.
· What are the consequences of the event happening?
Council will continue to pay higher operating costs.
Halogen lighting technology will become more expensive and difficult to acquire as it progresses towards obsolescence.
Council may fall behind with Smart cities technologies as these replacements will include ports to install smart devices.
· What is the likelihood of the event happening?
Unlikely, as Essential Energy will progress with the upgrade.
· Adequacy of existing controls?
This report offers adequate controls for the foreseeable future.
· Treatment options to mitigate the risk?
Support the LED Program rollout.
Conclusion
Essential Energy will roll out the LED light upgrade in the 2021-22 financial year. Council can choose to pay upfront, collect the savings immediately or wait for 10 years to receive the savings, and may retain the existing decorative light styles.
MURRAY RIVER COUNCIL Ordinary Council Meeting Agenda |
27 April 2021 |
9.4 Director Planning and Environment Report and Supplementary Matters
File Number: -
Author: Rod Croft, Interim Director Planning & Environment
Authoriser: Terry Dodds, Chief Executive Officer
That the Planning & Environment Directorate - Monthly Activity Report for the period 1 March to 31 March 2021 be received and the information noted by the Council. |
Discussion
This report details the activities of Council’s Planning and Environment Directorate from 1 March to 31 March 2021.

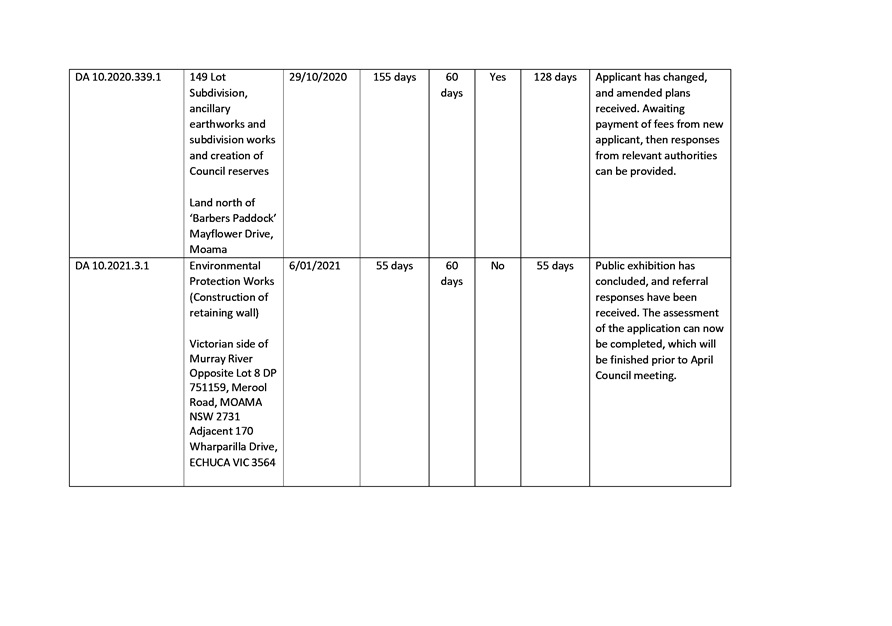

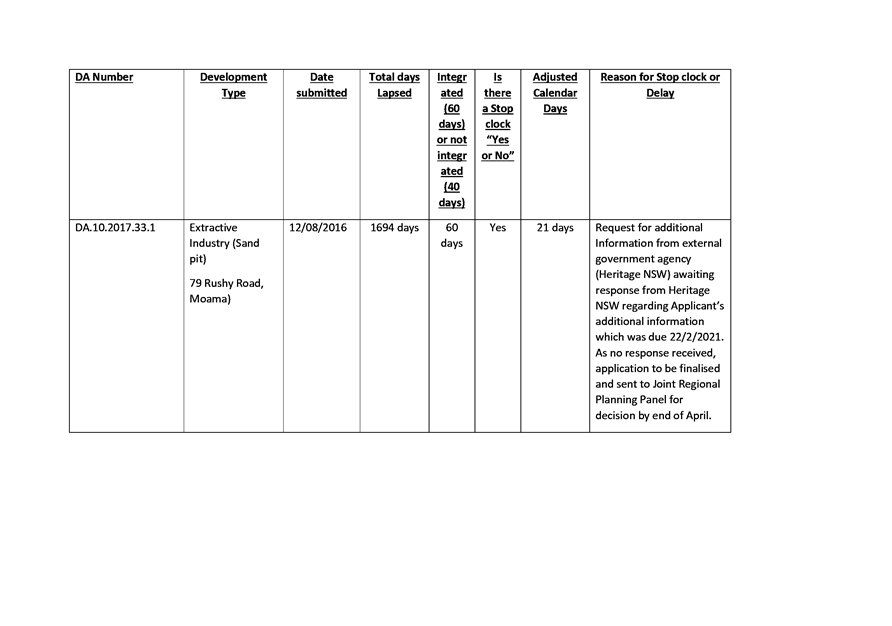

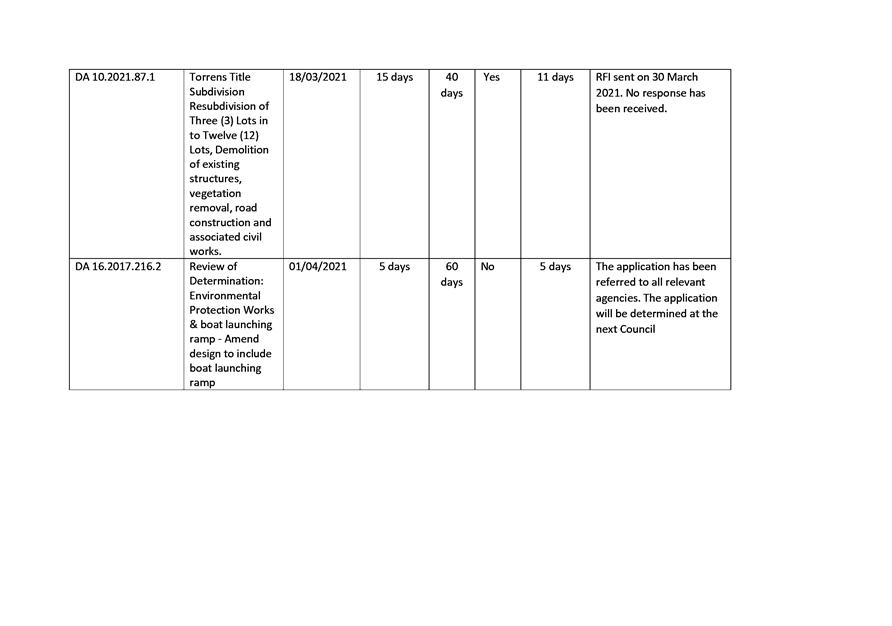

1. Applications

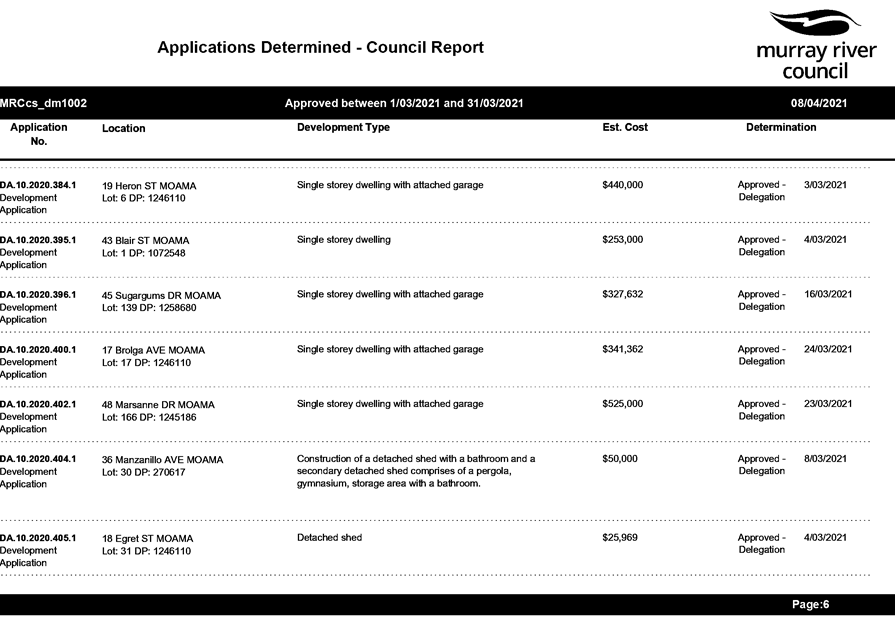

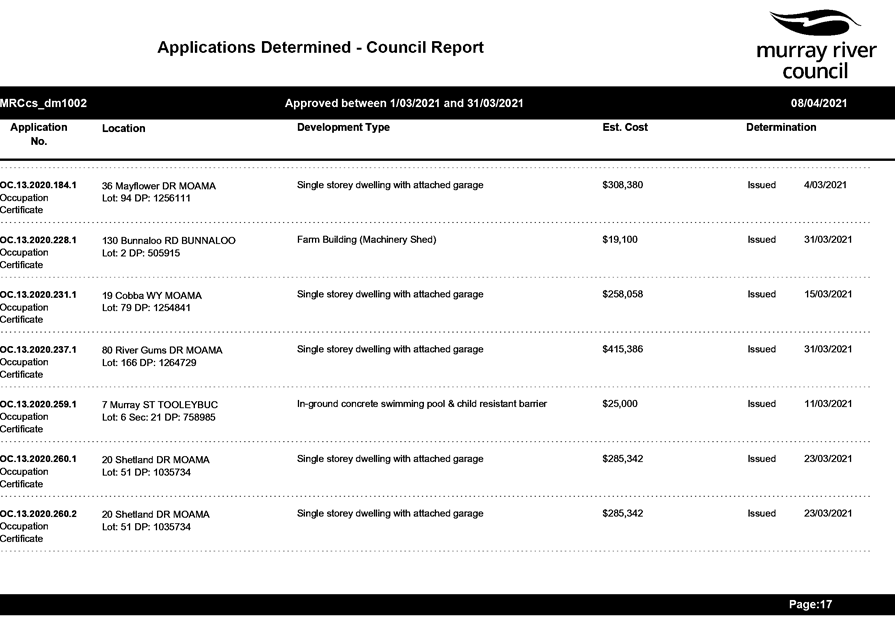

Determined - March 2021 ⇩
2. Application
Key Performance Summary – Outstanding Applications as at 8 April 2021 ⇩
3. DA
Performance Report Planning - March 2021 ⇩
4. Compliance
Report - March 2021 ⇩
5. Waste
Report - March 2021 ⇩
MURRAY RIVER COUNCIL Ordinary Council Meeting Agenda |
27 April 2021 |
File Number: -
Author: Melanie Squires, Strategic Planner
Authoriser: Gavin Carlisle, Interim Director Planning & Environment
That the Officer’s report on Murray River Council Draft Companion Animal Breeding Policy - Post Consultation Update as at 27 April 2021 be received and the information noted by the Council. |
Discussion
The Murray River Council Draft Companion Animal Breeding Policy was placed on public exhibition from 8 January 2021 to 18 February 2021 (a minimum period of 42 days) as per Council Resolution 171220 from the December meeting.
This report provides a summary of the submissions received and Council’s response to issues raised.
The Draft Companion Animal Breeding Policy was placed on exhibition via the following methods:
• Advertised on Council’s website
• Advertised in local newspapers (Riverine Herald, Pastoral Times Deniliquin, The Guardian Swan Hill, Koondrook Barham Bridge, Moulamein Wongi, Gannawarra Times)
• Hard copy of information available at all Council offices
Council received four detailed submissions from animal welfare organisations and no submissions from the general public.
A table setting out a summary of submissions and Council’s response to each has been included in Attachment 1. Council received preliminary contact from a number of parties, whose comments were taken into consideration as part of the draft Policy released for public consultation.
A full copy of all original submissions can also be provided upon request.
Council Staff will now be reflecting the relevant changes identified through public consultation (where appropriate) into the Final Policy. The Final Policy will also be formatted to reflect the theme for current Council policies. The final version of the policy is intended to be presented at the May or June 2021 Ordinary Council meetings for consideration and adoption.
Through the course of assessment of a separate development application for an animal breeding establishment, Council received legal advice outlining that Council cannot use knowledge of any previous criminal activity (i.e. ascertained via a Police Check) as the basis for refusal of a Development Application. As such, policy statement 1.b will be removed when the Final Policy is presented to Council.
It is also worth noting that state legislative reforms are progressing with the NSW Upper House passing an amendment to the Prevention of Cruelty to Animals Act 1979 (POCTA) requiring State Government to update the Animal Welfare Code of Practice - Breeding dogs and cats, by 31 May 2021. The amendment is still to be heard by the Lower House before it can pass as law. The next sitting of the Lower House is to be held on 4 May 2021.
1. Summary
of submissions to Murray River Council Draft Companion Animal Breeding Policy ⇩
MURRAY RIVER COUNCIL Ordinary Council Meeting Agenda |
27 April 2021 |
9.5 Director Community and Economic Development Report and Supplementary Matters
File Number: -
Author: John Harvie, Director Community and Economic Development
Authoriser: Terry Dodds, Chief Executive Officer
That Council 1. Adopt the Code of Conduct – Vulnerable People and Children Policy and place on public exhibition for a period of 28 days to enable public comment. 2. Request that the Chief Executive Officer write to Riverina and Murray Joint Organisation seeking its support to: a) Appoint a consultant to undertake Childsafe Audits of member councils (external) b) Appoint a Childsafe Officer on a fixed term contract to engage with individual member councils to rectify deficiencies identified in their Childsafe Audit, including: · Identify the risks/gaps observed as non-compliant to the Childsafe Standards. · Make immediate adjustments to high risk of high liability operational activities. · Formulate an implement a Childsafe Action Plan (continuous improvement plan) mapped to the Standards. · Oversee the implementation of the Childsafe Action Plan. · Monitor the Childsafe Action Plan implementation. · Induct Staff/Vol/Subcontractor/MRC Associates. · Develop the administrative documents for the Reportable Conduct Scheme obligations of RAMJO councils. · Conduct an evaluation, review and reporting of the implementation of the Childsafe Action Plan across RAMJO councils
|
Background
The NSW Children’s Guardian Act 2019 was enacted and came into effect in NSW on 1 March 2020 and resulted from the Federal Royal Commission into Institutional Responses to Child Sexual Abuse conducted between 2013 – 2017.
The Royal commissions finding lead to the creation of National Childsafe Principles and Standards which underpin the NSW Children’s Guardian Act 2019. The Standards provide a framework for enabling organisations to deliver childsafe services to children and have been accepted by the NSW Government.
Discussion
Implementation of the act in NSW is the responsibility of The Office of the Children’s Guardian who will monitor and hold accountable individuals and organisations, including council’s, in relation to ensuring children’s safety through implementation and adherence to the ten standards.
There are 10 Child Safe Standards
1. Leadership within the organisation is committed to children’s safety. Young people are asked and listened to
2. Children are encouraged to feel included and participate in decision-making
3. Families and communities are valued as active participants in keeping young people safe
4. Equal opportunities enable children to participate to their full potential
5. Recruitment of appropriate staff and volunteers to keep young people safe is a high priority and is taken seriously
6. Complaints are taken seriously and children are the priority when responding to complaints of abuse.
7. Organisations have a culture of educating and training to build staff skills, abilities and confidence
8. Physical and online environments are screened and adapted to identify and minimise risks to young people
9. Continuous review and improvement is a core component of the implementation of the Child Safe Standards within the organisation
10. Policies and procedures are developed and shared within the organisation in a way that is clearly understood by all workers
To identify gaps and develop sound policy council officers have engaged with The NSW Office of the Children’s Guardian and The Local Government Childsafe Network
The NSW Office of the Children’s Guardian
- Provides initial and ongoing training and induction to the NSW Reportable Conduct Scheme
- Clarifies individual organisations responsibilities.
- Provides Resources including templates of Policies/Procedures
The LG Childsafe Network
- Provides active email networking of NSW metro/regional Councils to navigate through their individual Childsafe Review activities, providing peer support
- Offers network sharing of Policies, Procedures and challenges/scenarios
In addition, Murray River Council will prepare a report to RAMJO seeking to:
1. Appoint a consultant to undertake Childsafe Audits of member councils (external)
2. Appoint a Childsafe Officer on a fixed term contract to engage with individual member councils to rectify deficiencies identified in their Childsafe Audit, including:
· Identify the risks/gaps observed as non-compliant to the Childsafe Standards
· Make immediate adjustments to high risk of high liability operational activities
· Formulate an implement a Childsafe Action Plan (continuous improvement plan) mapped to the Standards
· Oversee the implementation of the Childsafe Action Plan
· Monitor the Childsafe Action Plan implementation
· Induct Staff/Vol/Subcontractor/MRC Associates
· Develop the administrative documents for the Reportable Conduct Scheme obligations of RAMJO councils
· Evaluation, Review and Reporting of the implementation of the Childsafe Action Plan across RAMJO councils
This legislation is applicable to everyone. In our case, it applies to all employees who come in contact with children either directly or indirectly in the course of their employment with MRC.
Strategic Implications
3 - Strategic Theme 3: Social Wellbeing
3.1 - Enable community access to services, programs and facilities to support and enhance health, wellbeing, and community safety
3.1.8 - Work across all services for the prevention of domestic violence
Budgetary Implications
Council should budget an amount of $50,000 in the 2021/22 budget to cover the costs associated with compliance with the legislation.
Policy Implications
Nil.
Legislative Implications
Risk Analysis
· What can happen?
· Council does not adopt the Code of Conduct – Vulnerable People and Children and does not comply with the requirements of the NSW Children’s Guardian Act 2019.
· How can it happen?
· Poor governance and lack of leadership by the executive and others.
· What are the consequences of the event happening?
· Council may be at significant risk of being sued if it was found guilty of negligently or wilfully being non-compliant with the NSW Children’s Guardian Act 2019.
· What is the likelihood of the event happening?
· Unlikely
· Adequacy of existing controls?
· Not adequate to comply.
· Treatment options to mitigate the risk?
· Do all things necessary to be compliant with the NSW Children’s Guardian Act 2019.
Conclusion
MRC should adopt the recommendations of this report.
1. Code
of Conduct Policy - Vulnerable People and Children ⇩
MURRAY RIVER COUNCIL Ordinary Council Meeting Agenda |
27 April 2021 |
File Number: -
Author: John Harvie, Director Community and Economic Development
Authoriser: Terry Dodds, Chief Executive Officer
That Council 1. Agree to include the Murray Downs Community Garden within the scope of responsibility of the Murray Downs Riverside Park Management Committee.
|
Background
Until recently, the Murray Downs community was supported by the Murray Downs Advancement Group which met once each month.
The group also auspiced the Murray Downs Community Garden Group which was recently awarded Murray River Council’s Australia Day Community Group of the Year Award.
The Murray Downs Advancement Group recently ceased to operate and the Community Garden Group has asked whether council would agree to it becoming a sub-group of the Murray Downs Riverside Park Management Committee (MDRPMC).
Discussion
The community garden group is made up of members of the Murray Downs community who share an interest in gardening. The group enables like minded community members to come together to learn about gardening and to provide a forum for social interaction.
The garden complex is located at the rear of the Murray Downs RFS building and is accessible to all members.
Rather than become incorporated, the group would like to become part of the MDRPMC, which would provide volunteers and members protection through council’s public liability insurance cover and enable them to function as part of a formal and recognised body.
Strategic Implications
1 - Strategic Theme 1: Built/Physical Environment
1.3 - Improve and maintain community infrastructure
1.3.3 - Provide public facilities suitable for residential and visitor use (toilets, community halls)
Budgetary Implications
Nil
Policy Implications
Nil.
Legislative Implications
Risk Analysis
· What can happen?
Nil
· How can it happen?
Nil
· What are the consequences of the event happening?
Nil
· What is the likelihood of the event happening?
Nil
· Adequacy of existing controls?
Nil
· Treatment options to mitigate the risk?
Nil
Conclusion
That there would be positive outcomes for the Murray Downs community if council were to agree to widen the scope of the Murray Downs Riverside Park Management Committee to include the Murray Downs Community Garden.
1. Murray
Downs Community Gardens Letter ⇩
MURRAY RIVER COUNCIL Ordinary Council Meeting Agenda |
27 April 2021 |
File Number: -
Author: Sarah Ryan, Mananager Community and Economic Development
Authoriser: John Harvie, Director Community and Economic Development
That Council receive and note the April 2021 Funding Report. |
Background
The purpose of this report is to provide an update on current business and community funding opportunities.
Discussion
Council has received funding under the following program:
Transport for NSW - Fixing Local Roads – Round 2
Fixing Local Roads will provide support to Councils to repair, maintain or seal priority or important Local Roads.
Murray River Council |
To seal a section of 1.2km along the unsealed road Centre Rd. west of Mathoura. |
$456,000 |
Credit to Fred Groenewald and his team.
Council has recently applied for funding under the following programs:
Reducing Social Isolation for Seniors
|
Barham/Moulamein/Mathoura Library |
$13,000 |
Strategic Implications
4 - Strategic Theme 4: Economic Growth
4.1 - Encourage and support economic development across a range of sectors
4.1.2 - Support the local business sector to grow, adapt and respond to new opportunities
Budgetary Implications
Nil
Policy Implications
Nil.
Legislative Implications
Risk Analysis
· What can happen?
Nil
· How can it happen?
NA
· What are the consequences of the event happening?
NA
· What is the likelihood of the event happening?
NA
· Adequacy of existing controls?
NA
· Treatment options to mitigate the risk?
NA
Conclusion
Current community and business opportunities can be found via Council’s Grants Hub and have been distributed via the Economic Development, Community and Tourism Database.
MURRAY RIVER COUNCIL Ordinary Council Meeting Agenda |
27 April 2021 |
File Number: -
Author: Sarah Ryan, Mananager Community and Economic Development
Authoriser: John Harvie, Director Community and Economic Development
That Council receive the reports on Section 355 Committee Minutes and note the contents of the minutes. |
Background
Council Section 355 Committees are to provide minutes of each committee meeting to keep Council informed of the committee’s activities.
Discussion
Some, but not all, committees comply with this requirement. The Director Community and Economic Development and the Manager Economic Development and Tourism will work with all committees to help them to meet their obligations as required by S355 of the Local Government Act 1993.
The minutes received by Council during the period March-April are attached for Council’s information.
Strategic Implications
5 - Strategic Theme 5: Leadership and Governance
5.3 - Communication and collaboration identifies and meets community needs
5.3.1 - Council clearly identifies and promotes simple, effective communication, consultation and participation for community
Budgetary Implications
Nil
Policy Implications
Nil.
Legislative Implications
Risk Analysis
· What can happen?
Nil
· How can it happen?
NA
· What are the consequences of the event happening?
NA
· What is the likelihood of the event happening?
NA
· Adequacy of existing controls?
NA
· Treatment options to mitigate the risk?
NA
Conclusion
Council staff are highly engaged with Section 355 Committees, with scheduled face to face meetings now resuming.
1. Section
355 Committee Reports - April 2021 (under separate cover)
MURRAY RIVER COUNCIL Ordinary Council Meeting Agenda |
27 April 2021 |
File Number: -
Author: Jackie Ingwersen, Manager Community Services
Authoriser: John Harvie, Director Community and Economic Development
That Council approve the proposed 2021-22 Community access and associated Fee structure for defined Community Service locations across MRC |
Discussion
Council buildings that are currently accessed by the Community Services department to provide aged care community services, offers MRC the opportunity for these locations to
- be defined as Community Services locations, where through booking protocols,
- provide our Department with insight of external groups that are seeking access to them, which will
- develop networking and collaborative opportunities to deliver complimentary services
- align associated fees across these locations.
Additional benefit of Community Services (department) becoming more involved with these locations will enable the objective to encourage, attract and co-ordinate external visiting agencies to access these locations whom are seeking a fit for purpose building/room to meet with their clients.
Community Services is already making progress, attracting external visiting agencies to our towns, by way of offering our new Barham Community Services Hub to these agencies..
Current interest has been received from:
- Intereach family services
- Vinnies Welfare services/Barham
- Personnel Development Group (disability employment agency)
- Mission Australia (supporting young children and families)
- Australian Unity Homecare Services
1. Community
Services locations - proposed 2021-22 community access and fee structure ⇩
MURRAY RIVER COUNCIL Ordinary Council Meeting Agenda |
27 April 2021 |
File Number: -
Author: John Harvie, Director Community and Economic Development
Authoriser: Terry Dodds, Chief Executive Officer
That Council 1. Consider the contents of the Memorandum of Understanding proposed by the Moama Lions Community Village Management Committee and agreed to by the Lions Club of Moama. 2. If in agreement with the content and sentiment of the document, authorise the Mayor and Chief Executive Officer to sign and apply the seal of council.
|
Background
Since 1977 the Lions Club of Moama has been committed to providing affordable housing for older members of the Moama and District community.
Through collaboration with Murray Shire Council, now known as Murray River Council, the Moama Bowling Club and other members of the community, Moama Lions have constructed and now manage twenty-eight units valued at more than $7 million.
To ensure that ownership of the units will always remain with the community of Moama and district and that the benefits will be reaped well into the future, the lions club vested ownership of the assets to Murray River Council.
Discussion
The history of the Moama Lions Community Village and the tireless efforts of the Lions Club of Moama, past, present, and future, in partnership with Murray River Council, the Moama Bowling Club and the Moama Community should never be forgotten.
To that end, the Moama Lions Community Village Management Committee considered and agreed that the history and success of the Moama Lions Community Village should be captured in a formal document for the benefit and knowledge of the Moama and district community and current and future councillors of Murray River Council.
The Memorandum of Understanding attached to this report, between Murray River Council and The Lions Club of Moama, also contains the following important statement:
“It is the earnest wish of the ‘Lions’ that Murray River Council, now and in the future, treasure and pursue the ‘Lions’ vision and maintain their legacy in perpetuity should Moama Lions Club ever cease to exist”.
The Lions Club of Moama, at a meeting on 13 April 2021, agreed to the wording of the MOU and have invited Murray River Council to consider and, if thought appropriate, sign and apply the council seal to the Memorandum of Understanding.
Strategic Implications
5 - Strategic Theme 5: Leadership and Governance
5.2 - Engaged community leadership
5.2.1 - Council and community members actively lead and collaborate to bring the Community Strategic Plan and Vision to life; demonstrating innovative solutions, future thinking and forward planning
Budgetary Implications
Nil
Policy Implications
Nil.
Legislative Implications
Risk Analysis
· What can happen?
NA
· How can it happen?
NA
· What are the consequences of the event happening?
NA
· What is the likelihood of the event happening?
NA
· Adequacy of existing controls?
NA
· Treatment options to mitigate the risk?
NA
Conclusion
The Lions Club of Moama, Murray River Council and others have collaborated over the last 44 years to bring into being the vision of the lions named in the MOU.
It is important that the endeavours and achievements of everyone involved in this hugely successful project is documented for the knowledge of future generations.
1. Letter
From Lions Club of Moama ⇩
2. Memorandum
of Understanding ⇩
MURRAY RIVER COUNCIL Ordinary Council Meeting Agenda |
27 April 2021 |
File Number: -
Author: Lindy Leyonhjelm, Executive Assistant
Authoriser: Terry Dodds, Chief Executive Officer
That the Correspondence Report be received and the information noted by the Council. |
Discussion
Office of Local Government
· OLGNSW Flood update – 23 Mar 2021
· OLGNSW Council Update – 25 Mar 2021
· OLGNSW Nominations for Ministers Awards for Women in Local Government – 29 Mar 2021
· OLGNSW COVID-19 Council Update – 31 Mar 2021
· OLGNSW Council Circular 21-02 Temporary exemption form the requirement for councillors tot attend meetings in person – 1 Apr 2021
· OLGNSW COVID-19 Council Update – 14 Apr 2021
MINISTER HANCOCK OLGNSW Fortnightly Newsletter
· OLG’s Fortnightly Newsletter – 1 Apr 2021
· OLG’s Letter from Minister Hancock – 1 Apr 2021
· OLG’s Fortnightly Newsletter – 16 Apr 2021
Independent Commission Against Corruption
· Free ICAC Online Corruption Prevention Workshops registration email - 23 Mar 2021
Inside Local Government
· Inside Local Government Email update – 25 Mar 2021
· Inside Local Government Email update – 29 Mar 2021
· Inside Local Government Email update – 1 Apr 2021
· Inside Local Government Email update – 8 Apr 2021
· Inside Local Government Email update – 12 Apr 2021
· Inside Local Government Email update – 15 Apr 2021
The Riverine Grazier
· The Riverine Grazier edition – 14 Apr 2021
General correspondence
· Inner West Council Jobseeker Support – 23 Mar 2021
1. OLG
NSW Flood update 23 March 2021 ⇩
2. OLG
NSW Council Update 25 March 2021 ⇩
3. OLG
NSW Nominations for Ministers Awards for Women in Local Government 29 March
2021 ⇩
4. OLG
NSW Covid-19 Council Update 31 March 2021 ⇩
5. Council
Circular 21-02 Temporary exemption from the requirement for councillors to
attend meetings in person ⇩
6. OLG
NSW Covid-19 Council Update 14 April 2021 ⇩
7. OLG
NSW Fortnightly Newsletter Minister Hancock 1 April 2021 ⇩
8. OLG
NSW Letter from Minister Hancock 1 April 2021 ⇩
9. OLG
NSW Fortnightly Newsletter Minister Hancock 16 April 2021 ⇩
10. Free ICAC
Online Corruption Prevention Workshops registration email 23 March 2021 ⇩
11. Inside
Local Government 25 March 2021 ⇩
12. Inside
Local Government 29 March 2021 ⇩
13. Inside
Local Government 1 April 2021 ⇩
14. Inside
Local Governemnt 8 April 2021 ⇩
15. Inside
Local Government 12 April 2021 ⇩
16. Inside
Local Governemnt 15 April 2021 ⇩
17. 14th April
The Riverine Grazier ⇩
18. Inner West
Council Jobseeker Support 23 March 2021 ⇩
MURRAY RIVER COUNCIL Ordinary Council Meeting Agenda |
27 April 2021 |
File Number: -
Author: Lindy Leyonhjelm, Executive Assistant
Authoriser: Terry Dodds, Chief Executive Officer
That the Sundry Delegates Report of the Mayor and Councillors for the period 23 March 2021 to 26 April 2021 be received and the information noted by the Council; and reasonable out of pocket expenses be met by Council. |
Discussion
The Mayor, Councillor Chris Bilkey reported on his attendance at the following meetings and functions:
· Mar 23: Council Pre-Briefing & Ordinary Council Meeting - Moama
· Mar 23: Business Case presentation – volunteering resource center
· Mar 24: MRE Audit interview & Interview with 2QN
· Mar 25: Clubsgrant committee meeting
· Mar 25: Murray Socio Economic Activation Taskforce meeting via Zoom
· Mar 26: Travel to Albury and meet with The Hon Sussan Ley MP
· Mar 31: Interview with 2QN & Fortnightly Councillor Update via Teams
· Mar 31: RAMJO Murray and Murrumbidgee Regional Water Strategies via Zoom
· Apr 7: Interview with 2QN
· Apr 9: Interview with EMFM & meet at Winbi Resort
· Apr 14: Fortnightly Councillor Update via Teams
· Apr 16: Teams meeting with Hon Paul Toole MP RE: Swan Hill Bridge
· Apr 20: Griffith visit – meetings with Ministers regarding water
· Apr 21: Griffith visit– meetings with Ministers regarding water
· Apr 22: Community Grants Assessment Panel – Shortlist meeting
· Apr 23: Moama Public School Anzac Day service
· Apr 25: Moama Wreath Laying Ceremony
The Deputy Mayor, Councillor Nikki Cohen reported on hierattendance at the following meetings and functions:
· Mar 23: Councillor visit to Four Post Recreation & Campground Deniliquin
· Mar 23: Council Pre-Briefing & Ordinary Council Meeting - Moama
· Mar 31: Fortnightly Councillor Update via Teams
· Apr 9: Audit and Risk Committee Work Plan Discussion - Moama
· Apr 12: Audit and Risk Committee Meeting - Moama
· Mar 14: Fortnightly Councillor Update via Teams
· Apr 19: Lawry Park Community Consultation – Rich River Golf Club
· Apr 25: Anzac Day Ceremonies Echuca/Moama
Councillor Tony Aquino reported on his attendance at the following meetings and functions:
· Mar 23: Councillor visit to Four Post Recreation & Campground Deniliquin
· Mar 23: Council Pre-Briefing & Ordinary Council Meeting - Moama
· Mar 23: Planning stakeholders meeting
· Mar 29: Meeting with P Hill & T Dodds
· Mar 31: Fortnightly Councillor update – CEO office
· Apr 14: Fortnightly Councillor update – via Teams
Cr Tony Aquino reported on his attendance at the following meetings and functions for dates prior to 23 March:
· Mar 18: Integrated Service Management Workshop - Moama
· Mar 21: Barham Site inspection re: deputation
· Mar 22: Site inspection re: truck traffic
Councillor Gen Campbell reported on her attendance at the following meetings and functions:
· Mar 23: Councillor visit to Four Post Recreation & Campground Deniliquin
· Mar 23: Council Pre-Briefing & Ordinary Council Meeting - Moama
Cr Gen Campbell reported on her attendance at the following meetings and functions for dates prior to 23 March:
· Mar 15: Lions meeting
· Mar 16: Liquor Accord
· Mar 22: National Timber Councils AGM meeting
Councillor Alan Mathers reported on her attendance at the following meetings and functions:
· Mar 23: Council Pre-Briefing & Ordinary Council Meeting - Moama
· Mar 31: Fortnightly Councillor update – CEO office
· Apr 25: MRC Anzac Day ceremony’s at Barham and Wakool.
Cr Alan Mathers reported on her attendance at the following meetings and functions for dates prior to 23 March:
· Mar 1: Wakool Hall Committee
· Mar 22: MRC Workshop interview with Centium RE: Murray River Energy
Councillor Ann Crowe reported on her attendance at the following meetings and functions:
· Apr 2: Murray Downs Riverside Park Committee of Management General meeting -Federal Hotel
· Apr 9: Meeting with Toby Gilmour & John Harvie – via phone
· Apr 14: Fortnightly Councillor Update via Teams
· Apr 25: Anzac Day Ceremonies Piangil
Councillor Neil Gorey reported on his attendance at the following meetings and functions:
Cr Neil Gorey reported on his attendance at the following meetings and functions for dates prior to 23 March:
· Mar 8: Barham Recreation reserve meeting
· Mar 10: Councillor update – via Teams
· Mar 15: NCTA meeting
· Mar 17: Councillor update – via Teams
Councillor Thomas Weyrich reported on his attendance at the following meetings and functions:
No report provided.
Councillor Geoff Wise reported on his attendance at the following meetings and functions:
· Mar 23: Pre-briefing meeting, Ordinary Council Meeting
· Mar 23: Planning stakeholders meeting
MURRAY RIVER COUNCIL Ordinary Council Meeting Agenda |
27 April 2021 |
10 Notice of Motions/Questions with Notice
10.1 Notice of Motion -That Council conduct an investigation as to the feasibility of developing and subdividing property in Mathoura
File Number: -
I, Councillor Thomas Weyrich, give notice that at the next Ordinary Meeting of Council to be held on 27 April 2021, I intend to move the following rescission motion:-
That Council conduct and investigation as to the feasibility of developing and subdividing the property on the corners of Cobb Highway, Jones and Mathoura Streets. 1. Type Recommendation here (a) Type Recommendation here (i) Type Recommendation here
|
Rationale
Type here
I commend this Notice of Motion to Council.
MURRAY RIVER COUNCIL Ordinary Council Meeting Agenda |
27 April 2021 |
10.2 Notice of Motion - That Council conduct a cost benefit ratio in respect to the supply of raw water to Mathoura township.
File Number: -
I, Councillor Thomas Weyrich, give notice that at the next Ordinary Meeting of Council to be held on 27 April 2021, I intend to move the following rescission motion:-
That Council conduct a cost benefit ratio and that Council receive a report in respect to the supply of raw water to Mathoura township. 1. Type Recommendation here (a) Type Recommendation here (i) Type Recommendation here
|
Rationale
Type here
I commend this Notice of Motion to Council.
MURRAY RIVER COUNCIL Ordinary Council Meeting Agenda |
27 April 2021 |
File Number: -
I, Councillor Thomas Weyrich, give notice that at the next Ordinary Meeting of Council to be held on 27 April 2021, I intend to move the following rescission motion:-
That Council investigate the cost of purchasing a street sweeper compared to the cost associated with utilising a contractor to clean streets. 1. Type Recommendation here (a) Type Recommendation here (i) Type Recommendation here
|
Rationale
Type here
I commend this Notice of Motion to Council.
MURRAY RIVER COUNCIL Ordinary Council Meeting Agenda |
27 April 2021 |
File Number: -
I, Councillor Geoff Wise, give notice that at the next Ordinary Meeting of Council to be held on 27 April 2021, I intend to move the following rescission motion:-
That Council advise why farmers were told to stop cultivating the strip on council land outside their properties 1. Type Recommendation here (a) Type Recommendation here (i) Type Recommendation here
|
Rationale
This is ridiculous by cultivating the strips of land outside their properties they were protecting first their valuable fencing then their pastures and crops.
Then livestock an extremely costly resource followed by homes and outbuildings and valuable machinery.
Last but not least human lives are at risk from fires.
We live in the driest continent on earth.
However, we sometimes have great seasons building up the flammable material along our roads, this can cause catastrophic problems for farmers
These people need to have the right to some initial form of protection.
The community in the urban areas are allowed to cut their nature strips.
Why do we leave farmers with no initial protection?
This could be done subject to them controlling any noxious weeds on the cultivated areas.
I commend this Notice of Motion to Council.
MURRAY RIVER COUNCIL Ordinary Council Meeting Agenda |
27 April 2021 |
